Project cost · modeled example · 4 builds

Cost to Build a House (2026): $232,003 to $612,393

Building a new single-family house costs about $232,003 to $259,843 for a 1,050 sf two-bedroom cottage up to $546,780 to $612,393 for a 2,400 sf four-bedroom two-story over a full unfinished basement. Four new houses, fully itemized: a 1,050 sf cottage, a builder-grade 1,500 sf and a mid-grade 1,600 sf slab ranch, and a 2,400 sf two-story over a full basement. Every quantity, rate and formula shown, with crew hours.

Direct answer: Building a new single-family house costs about $232,003 to $259,843 for a 1,050 sf two-bedroom cottage up to $546,780 to $612,393 for a 2,400 sf four-bedroom two-story over a full unfinished basement, from a direct job cost of $185,602 and $437,424. Direct job cost is labor and materials only, with no contractor overhead or profit, and is not a price: no contractor performs work at job cost. Permit and inspection fees are not included.

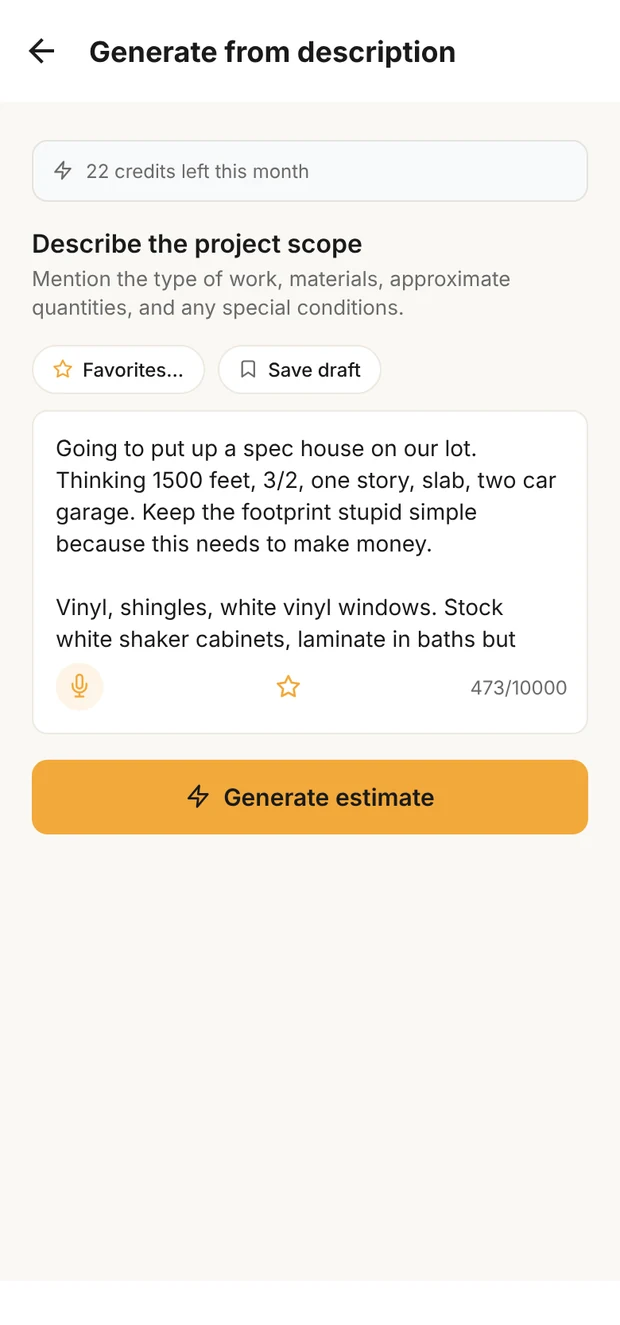

Clamp's Generate from description screen with the 1,500 sf spec ranch described in plain words

Describe the house

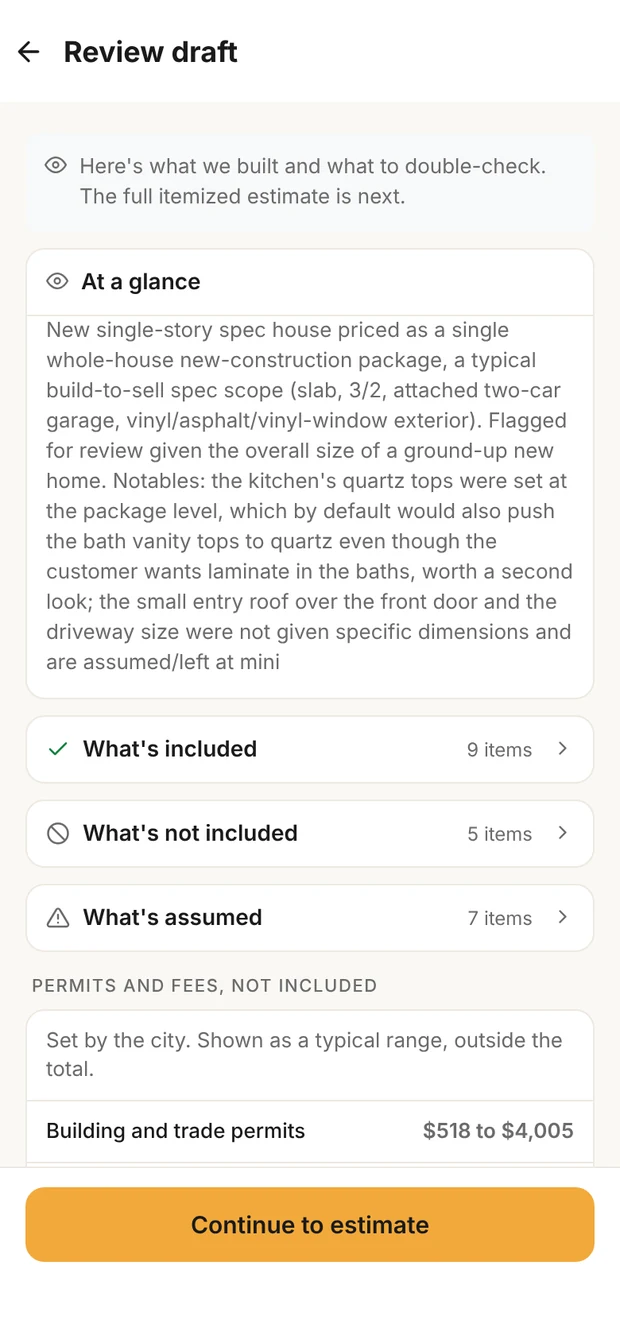

Clamp's review draft for the spec house: at a glance summary, what's included, not included and assumed, with permits shown outside the total

Review the draft

The 1,500 sf ranch in the Clamp app: the job described the way a builder would text it, then the review draft with what's included, what's not and what's assumed, before the itemized estimate. The draft even flags the vanity-top question this page's build pins to laminate. Sample data.

Four builds, side by side

Four houses on the same researched baseline rates: a 1,050 sf cottage, a builder-grade 1,500 sf spec ranch, a mid-grade 1,600 sf ranch, and a 2,400 sf two-story over a full unfinished basement. Size and finish both step up from build to build.

BuildJob costLaborCrew hoursMaterialsIllustrative selling price
A. 1,050 sf cottage$185,602$75,9641201 to 1423 h$81,198$232,003 to
$259,843
B. 1,500 sf spec ranch, builder grade$252,793$98,9881529 to 1817 h$115,427$315,992 to
$353,911
C. 1,600 sf ranch, mid grade$279,307$104,7721635 to 1940 h$135,866$349,134 to
$391,030
D. 2,400 sf two-story$437,424$174,3692916 to 3450 h$206,714$546,780 to
$612,393

Materials include allowances. Illustrative selling price is the job cost at a 25% to 40% markup; your price depends on your own overhead and profit. Labor hours are a planning range and include setup, daily cleanup and material runs; they are never a charge to the customer. Permit and inspection fees are not included; requirements vary by jurisdiction.

Each build in detail

A. 1,050 sf cottage: $185,602

Two bedrooms and one bath on a crawlspace, vinyl siding, stock cabinets with laminate tops, LVP, an electric heat pump and a 40 foot gravel driveway. No garage. Labor is $75,964 of the $185,602 job cost, or 40.9%. It is about 1201 to 1423 hours of work, including setup, daily cleanup and material runs.

Labor cost by trade

Labor only. Materials, allowances and dump fees are in the line items below. Hours are person-hours at typical production from Clamp’s labor hours catalog, as a range: a planning figure, not a schedule and not a charge to the customer.

TradeHoursLabor costLean×1.25Standard×1.30Full-Service×1.40
Sitework18 to 28 h$1,787$2,234$2,323$2,502
Masonry85 to 144 h$4,804$6,005$6,245$6,726
Plumbing53 to 71 h$5,293$6,616$6,881$7,410
Electrical122 to 168 h$13,598$16,998$17,677$19,037
HVAC73 to 109 h$7,670$9,588$9,971$10,738
Insulation15 to 34 h$1,156$1,445$1,503$1,619
Drywall104 to 174 h$3,497$4,371$4,546$4,896
Carpentry224 to 289 h$18,496$23,120$24,045$25,894
Tile14 to 23 h$1,004$1,255$1,305$1,406
Flooring13 to 26 h$2,142$2,678$2,785$2,999
Painting73 to 101 h$4,956$6,195$6,443$6,938
Cabinets & Countertops12 to 20 h$1,116$1,395$1,451$1,562
Vanity & Fixtures3 to 8 h$490$612$637$686
Appliances6 to 9 h$515$644$669$721
Exterior50 to 75 h$3,678$4,597$4,781$5,149
Cleanup & Disposal12 to 49 h$2,100$2,625$2,730$2,940
Roofing30 to 48 h$3,662$4,577$4,761$5,127
Setup, cleanup and material runs85 to 257 hin the prices
All labor1201 to 1423 h$75,964$94,955$98,753$106,350

Every line item

Labor $75,964 + materials and allowances $81,198 + dump fees and other $28,440 = $185,602 direct job cost. Hours are person-hours at typical production, on labor rows only, and the direct-cost row adds about 15% for setup, daily cleanup and material runs; an allowance or material row names the labor line that installs it, and a subcontract row has none, because the sub’s price includes their own time. Some labor quantities include a difficulty factor, so they can exceed the measured area; each row’s derivation is in the downloadable data.

ItemQtyUnitHoursLaborMaterialLine cost
Sitework
Compacted Gravel Base (per sf)480sf$0$653$653
Silt Fence Install Labor228lf3 to 8 h$319$0$319
Excavation Equipment Rental1day$0$0$550
Exterior Footing Drain (per lf)136lf$0$0$1,904
Foundation Excavation (Machine, Per Cubic Yard)61.58cy$0$0$985
Gravel Base Spread and Compact Labor, Machine (per sf)480sf4 to 11 h$499$0$499
Driveway Crew Mobilization (per job)1ea2 to 6 h$325$0$325
Portable Toilet Rental (per month)5month$0$0$1,125
Silt Fence Materials (per lf)Labor on: Silt Fence Install Labor250.8lf$0$213$213
Site Grading Labor2929sf3 to 8 h$644$0$644
Site Survey and Building Staking (per project)1ea$0$0$1,200
Temporary Power Monthly Service (per month)5month$0$0$825
Temporary Power or Water Hookup (One-Time)2ea$0$0$2,100
Utility Locate Service1ea$0$0$450
Sitework subtotal18 to 28 h$11,792
Sitework subtotal18 to 28 h$11,792
Masonry
Concrete Flatwork Install Labor72sf2 to 5 h$223$0$223
Concrete Flatwork MaterialsLabor on: Concrete Flatwork Install Labor79.2sf$0$416$416
Concrete Footing Install Labor147lf22 to 48 h$1,544$0$1,544
Concrete Footing MaterialsLabor on: Concrete Footing Install Labor161.7lf$0$2,345$2,345
Foundation Dampproofing, Spray Applied408sf$0$0$510
Foundation Pour Labor13.5cy49 to 103 h$3,037$0$3,037
Foundation Pour MaterialsLabor on: Foundation Pour Labor14.85cy$0$4,232$4,232
Crawlspace Ground Vapor Retarder (per sf)1050sf$0$0$577
Masonry subtotal85 to 144 h$12,884
Masonry subtotal85 to 144 h$12,884
Plumbing
DWV Install Labor10lf3 to 7 h$360$0$360
Expansion TankLabor on: Expansion Tank Install Labor1ea$0$75$75
Expansion Tank Install Labor1ea1 to 2 h$110$0$110
Faucet Allowance (Kitchen, Utility or Outdoor)Labor on: Fixture Set Labor1ea$0$100$100
Kitchen Sink AllowanceLabor on: Fixture Set Labor1ea$0$360$360
Toilet AllowanceLabor on: Fixture Set Labor1ea$0$160$160
Fixture Set Labor5ea8 to 17 h$975$0$975
Hose Bib FixtureLabor on: Fixture Set Labor2ea$0$76$76
Kitchen Sink Trap and SuppliesLabor on: Fixture Set Labor1ea$0$45$45
DWV MaterialsLabor on: DWV Install Labor42.8lf$0$267$267
Plumbing Main Lines, New House (per sf)1050sf$0$0$4,462
Rough Plumbing ConsumablesLabor on: Plumbing Rough-In Per Fixture4ea$0$168$168
Plumbing Rough-In Per Fixture4ea10 to 22 h$1,600$0$1,600
Supply Pipe MaterialsLabor on: Supply Line Install Labor110.6lf$0$387$387
Sewer Cleanout AssemblyLabor on: Sewer Cleanout Install Labor1ea$0$95$95
Sewer Cleanout Install Labor1ea2 to 5 h$385$0$385
Sewer Lateral Install, Trenched and Backfilled (per lf)50lf$0$0$4,250
Shower Valve Trim AllowanceLabor on: Shower Valve Set and Trim Labor1ea$0$110$110
Shower Valve Set and Trim Labor1ea2 to 5 h$325$0$325
Shower Valve Rough-In BodyLabor on: Shower Valve Set and Trim Labor1ea$0$75$75
Shutoff Valve Install2ea1 to 2 h$116$0$116
Supply Line Install Labor28lf1 to 5 h$168$0$168
Toilet Setting MaterialsLabor on: Fixture Set Labor1ea$0$45$45
Alcove Tub Setting MaterialsLabor on: Fixture Set Labor1ea$0$65$65
Tub Unit AllowanceLabor on: Fixture Set Labor1ea$0$450$450
Tub Waste and Overflow KitLabor on: Fixture Set Labor1ea$0$65$65
Washer BoxLabor on: Washer Box Install Labor1ea$0$65$65
Washer Box Install Labor1ea1 to 3 h$230$0$230
Tank Water HeaterLabor on: Tank Water Heater Install1ea$0$750$750
Water Heater Connection KitLabor on: Tank Water Heater Install1ea$0$63$63
Tank Water Heater Install1ea1 to 4 h$297$0$297
Water Service Pipe Install Labor50lf2 to 6 h$212$0$212
Water Service Pipe MaterialsLabor on: Water Service Pipe Install Labor52.5lf$0$289$289
Water Service Pressure Test Labor1ea1 to 3 h$190$0$190
Water Service Trenching Labor50lf3 to 8 h$325$0$325
Plumbing subtotal53 to 71 h$17,715
Plumbing subtotal53 to 71 h$17,715
Electrical
Bath Fan Air Sealing Labor1eaunder 1 h$28$0$28
Bath Fan Duct Install Labor8lfunder 1 h$38$0$38
Bath Fan Duct MaterialsLabor on: Bath Fan Duct Install Labor9.2lf$0$25$25
Bath Fan Electrical Hookup Labor1ea1 to 2 h$100$0$100
Bath Fan Termination Install Labor1ea1 to 2 h$110$0$110
Bath Fan Termination MaterialsLabor on: Bath Fan Termination Install Labor1ea$0$45$45
Bath Fan Housing Install Labor1ea1 to 3 h$190$0$190
Bath Fan Airflow Check1eaunder 1 h$30$0$30
Bathroom Exhaust Fan UnitLabor on: Bath Fan Housing Install Labor1ea$0$215$215
New Branch Circuit Install Labor (per circuit)16ea33 to 70 h$4,320$0$4,320
New Appliance Circuit Install Labor1ea2 to 5 h$275$0$275
Dedicated Circuit BreakerLabor on: New Branch Circuit Install Labor (per circuit)5ea$0$108$108
240V Outlet Install1ea1 to 4 h$235$0$235
Underground Electric Service Lateral (per lf)50lf$0$0$1,400
Electrical Box and Device MaterialsLabor on: Electrical Rough-In Per Device60ea$0$510$510
Electrical Rough ConsumablesLabor on: Electrical Rough-In Per Device22ea$0$143$143
Electrical Rough-In Per Device56ea21 to 46 h$2,352$0$2,352
GFCI Receptacle or AFCI Breaker Install6ea1 to 5 h$288$0$288
GFCI UnitLabor on: GFCI Receptacle or AFCI Breaker Install6ea$0$120$120
HVAC Condenser DisconnectLabor on: Air Source Heat Pump Install1ea$0$35$35
Light Fixture AllowanceLabor on: Light Fixture Install8ea$0$400$400
Light Fixture Install8ea4 to 10 h$680$0$680
Lighting DimmerLabor on: Outlet/Switch Install1ea$0$28$28
Meter SocketLabor on: Service Meter and Riser Install1ea$0$150$150
NM Cable 10/3 (30 A, 240 V)Labor on: New Branch Circuit Install Labor (per circuit)184lf$0$340$340
Outlet/Switch Install43ea6 to 15 h$1,290$0$1,290
Outlet UnitLabor on: Outlet/Switch Install29ea$0$88$88
Recessed Light (Can or Wafer)Labor on: Recessed Light Install Labor, Open Ceiling16ea$0$508$508
Recessed Light Install Labor, Open Ceiling16ea6 to 14 h$832$0$832
Romex Wire MaterialsLabor on: Electrical Rough-In Per Device1463.6lf$0$1,171$1,171
Service Meter and Riser Install1ea4 to 10 h$1,200$0$1,200
Service PanelLabor on: Service Panel Install Labor1ea$0$950$950
Service Panel Install Labor1ea5 to 13 h$1,450$0$1,450
Smoke and CO DetectorLabor on: Smoke/CO Detector Install4ea$0$220$220
Smoke/CO Detector Install4ea1 to 3 h$180$0$180
Switch UnitLabor on: Outlet/Switch Install15ea$0$35$35
Electrical subtotal122 to 168 h$20,089
Electrical subtotal122 to 168 h$20,089
HVAC
Exterior Vent Cap Install (Hood or Dryer)1ea1 to 3 h$195$0$195
Backup Strip HeatLabor on: Backup Strip Heat Install Labor1ea$0$275$275
Backup Strip Heat Install Labor1ea1 to 4 h$225$0$225
Condensate Drain Install1ea1 to 3 h$150$0$150
Dryer Vent Install Labor10lf1 to 3 h$165$0$165
Dryer Vent MaterialsLabor on: Dryer Vent Install Labor11lf$0$47$47
Dryer Vent Termination1ea$0$35$35
Ducted Heat Pump System Equipment (per system)Labor on: Air Source Heat Pump Install1ea$0$3,467$3,467
Ductwork Install216lf28 to 59 h$2,700$0$2,700
Ductwork MaterialsLabor on: Ductwork Install226.8lf$0$1,758$1,758
Air Source Heat Pump Install1ea14 to 30 h$2,700$0$2,700
HVAC Commissioning and Balance1ea1 to 5 h$340$0$340
HVAC Install Consumables1ea$0$285$285
HVAC Load Calculation Labor1ea2 to 6 h$340$0$340
Range Hood Duct Install Labor10lf1 to 4 h$95$0$95
Range Hood Duct MaterialsLabor on: Range Hood Duct Install Labor10lf$0$115$115
Refrigerant Line Set Install30lf1 to 4 h$255$0$255
Refrigerant Line MaterialsLabor on: Refrigerant Line Set Install34.5lf$0$293$293
Register BootLabor on: Ductwork Install12ea$0$384$384
Register and Grille Install12ea1 to 3 h$168$0$168
Return Duct Install Labor45lf1 to 5 h$247$0$247
Return Duct MaterialsLabor on: Return Duct Install Labor45lf$0$427$427
Standard Thermostat Install1ea1 to 2 h$90$0$90
Thermostat UnitLabor on: Standard Thermostat Install1ea$0$200$200
HVAC subtotal73 to 109 h$14,956
HVAC subtotal73 to 109 h$14,956
Insulation
Air Sealing Package, New Framing (per sf)1050sf$0$0$788
Attic Blown Insulation, Installed (per sf at R-49)1050sf$0$0$1,733
Floor Insulation from Below, Installed (per sf)1050sf$0$0$1,732
Rim Joist Insulation Install (per lf)136lf15 to 34 h$1,156$0$1,156
Rim Joist Rigid Foam (per lf)Labor on: Rim Joist Insulation Install (per lf)136lf$0$218$218
Wall Batt Insulation, Installed (per sf)896sf$0$0$941
Insulation subtotal15 to 34 h$6,568
Insulation subtotal15 to 34 h$6,568
Drywall
Drywall Finish Labor3885sf52 to 110 h$1,904$0$1,904
Drywall Hang Labor3885sf37 to 79 h$1,593$0$1,593
Drywall Sheets MaterialsLabor on: Drywall Hang Labor4273.5sf$0$2,607$2,607
Drywall subtotal104 to 174 h$6,104
Drywall subtotal104 to 174 h$6,104
Carpentry
Floor System Framing Labor1050sf34 to 71 h$3,675$0$3,675
Floor System Framing MaterialsLabor on: Floor System Framing Labor1102.5sf$0$4,961$4,961
Bathroom Accessory AllowanceLabor on: Bathroom Accessory Install Labor3ea$0$75$75
Bathroom Accessory Install Labor3ea1 to 2 h$84$0$84
Closet System AllowanceLabor on: Closet System Install26.4lf$0$1,188$1,188
Closet System Install24lf3 to 7 h$504$0$504
Crawlspace Access Door1ea$0$0$485
Door Lock Hardware AllowanceLabor on: Exterior Door Install2ea$0$190$190
Door Unit AllowanceLabor on: Exterior Door Install2ea$0$1,540$1,540
Exterior Door Install2ea4 to 10 h$1,000$0$1,000
Exterior Wall Framing MaterialsLabor on: Stud Wall Framing Install142.8lf$0$1,928$1,928
Framing Fasteners and HardwareLabor on: Stud Wall Framing Install220.5lf$0$243$243
Sheathing Install2468sf19 to 40 h$2,715$0$2,715
Stud Wall Framing Install267lf34 to 73 h$2,670$0$2,670
Interior Door Hardware AllowanceLabor on: Interior Door Install8ea$0$600$600
Interior Door Install8ea11 to 25 h$1,400$0$1,400
Interior Door AllowanceLabor on: Interior Door Install8ea$0$720$720
Partition Door Rough Opening8ea3 to 9 h$544$0$544
Porch Ceiling, Install Labor72sf2 to 6 h$378$0$378
Porch Ceiling MaterialLabor on: Porch Ceiling, Install Labor79.2sf$0$178$178
Porch Posts and Beam, Framing Labor13lf6 to 15 h$585$0$585
Porch Posts and Beam, MaterialsLabor on: Porch Posts and Beam, Framing Labor13lf$0$546$546
Roof Trusses and Roof Sheathing Materials (per roofing square)Labor on: Roof Truss Set and Brace (per roofing square)14.49square$0$7,028$7,028
Roof Truss Set and Brace (per roofing square)13.8square14 to 30 h$1,173$0$1,173
Base Shoe / Quarter Round Install23lfunder 1 h$31$0$31
Base Shoe / Quarter Round MaterialsLabor on: Base Shoe / Quarter Round Install25.3lf$0$32$32
Shower Curtain Rod AllowanceLabor on: Shower Curtain Rod Install Labor1ea$0$85$85
Shower Curtain Rod Install Labor1eaunder 1 h$55$0$55
Stud Wall Framing MaterialsLabor on: Stud Wall Framing Install144.1lf$0$973$973
Baseboard and Casing Install477lf12 to 26 h$1,312$0$1,312
Trim MaterialsLabor on: Baseboard and Casing Install796.7lf$0$1,673$1,673
Wall Sheathing MaterialsLabor on: Sheathing Install1196.8sf$0$1,137$1,137
Window Caulk and Flash MaterialsLabor on: Window Install10ea$0$480$480
Window and Door Install ConsumablesLabor on: Exterior Door Install2ea$0$96$96
Window Install10ea13 to 29 h$1,950$0$1,950
Window Stool and Apron Stock (per window)Labor on: Window Stool and Apron Install10ea$0$220$220
Window Stool and Apron Install10ea4 to 9 h$420$0$420
Window Unit AllowanceLabor on: Window Install10ea$0$3,000$3,000
Carpentry subtotal224 to 289 h$45,874
Carpentry subtotal224 to 289 h$45,874
Tile
Tile Grout Install Labor80sf1 to 4 h$140$0$140
Tile Grout MaterialsLabor on: Tile Grout Install Labor80sf$0$36$36
Bathroom Tile Install Labor80sf6 to 15 h$520$0$520
Floor Tile Material AllowanceLabor on: Bathroom Tile Install Labor88sf$0$220$220
Bath Tile Setting MaterialsLabor on: Bathroom Tile Install Labor88sf$0$75$75
Backsplash Tile Grout and Seal Labor21sfunder 1 h$9$0$9
Backsplash Tile Material AllowanceLabor on: Backsplash Tile Install Labor21sf$0$136$136
Backsplash Tile Setting MaterialsLabor on: Backsplash Tile Install Labor21sf$0$39$39
Uncoupling Membrane Labor80sf1 to 3 h$136$0$136
Uncoupling Membrane MaterialsLabor on: Uncoupling Membrane Labor80sf$0$196$196
Backsplash Tile Install Labor21sf1 to 5 h$199$0$199
Tile subtotal14 to 23 h$1,706
Tile subtotal14 to 23 h$1,706
Flooring
Floor Transition Install2ea1 to 2 h$80$0$80
Floor Transition MaterialsLabor on: Floor Transition Install5ea$0$175$175
Floor Underlayment Materials936sf$0$515$515
Flooring Install Consumables2ea$0$170$170
LVP/LVT Install936sf10 to 23 h$1,966$0$1,966
Door Threshold Transition Labor3ea1 to 3 h$96$0$96
LVP/LVT Material AllowanceLabor on: LVP/LVT Install1029.6sf$0$3,346$3,346
Flooring subtotal13 to 26 h$6,348
Flooring subtotal13 to 26 h$6,348
Painting
Interior Ceiling Paint Apply Labor1050sf6 to 14 h$588$0$588
Interior Door Paint (per door)8ea6 to 13 h$496$0$496
Interior Paint Apply Labor2865sf14 to 30 h$1,604$0$1,604
Paint Masking Setup Labor2865sfunder 1 h$29$0$29
Premium Paint AllowanceLabor on: Interior Paint Apply Labor29.37gallon$0$1,410$1,410
Paint Prep Labor2985sf5 to 12 h$269$0$269
Paint Primer Application Labor3597.8sf7 to 17 h$792$0$792
Primer MaterialsLabor on: Paint Primer Application Labor11.95gallon$0$382$382
Paint Sundries Materials1ls$0$150$150
Trim Caulk and Filler MaterialsLabor on: Trim Paint Apply Labor809lf$0$178$178
Trim Paint Apply Labor673lf15 to 33 h$1,178$0$1,178
Painting subtotal73 to 101 h$7,076
Painting subtotal73 to 101 h$7,076
Cabinets & Countertops
Cabinet Fillers, End Panels and Toe KickLabor on: Cabinet Install Labor12lf$0$300$300
Cabinet Hardware (per piece)27ea$0$68$68
Cabinet Install Fasteners and ShimsLabor on: Cabinet Install Labor17lf$0$38$38
Cabinet Install Labor17lf6 to 14 h$638$0$638
Cabinet Material AllowanceLabor on: Cabinet Install Labor17lf$0$3,060$3,060
Countertop Install, Laminate34sf2 to 6 h$238$0$238
Countertop Material, LaminateLabor on: Countertop Install, Laminate34sf$0$476$476
Countertop Seam Labor1eaunder 1 h$75$0$75
Countertop Sink Cutout Labor1ea1 to 2 h$165$0$165
Cabinets & Countertops subtotal12 to 20 h$5,058
Cabinets & Countertops subtotal12 to 20 h$5,058
Vanity & Fixtures
Vanity Install Fasteners and Shims5lf$0$11$11
Bathroom Sink AllowanceLabor on: Fixture Set Labor1ea$0$90$90
Vanity Top, Laminate (per sf)Labor on: Vanity Install Labor9.5sf$0$114$114
Bathroom Faucet AllowanceLabor on: Fixture Set Labor1ea$0$90$90
Sink Trap and SuppliesLabor on: Fixture Set Labor1ea$0$45$45
Vanity Cabinet AllowanceLabor on: Vanity Install Labor5lf$0$650$650
Vanity Install Labor1ea3 to 7 h$425$0$425
Vanity Mirror or Medicine Cabinet (per unit)Labor on: Vanity Mirror Install (per unit)1ea$0$55$55
Vanity Mirror Install (per unit)1eaunder 1 h$65$0$65
Vanity & Fixtures subtotal3 to 8 h$1,545
Vanity & Fixtures subtotal3 to 8 h$1,545
Appliances
Dishwasher Hookup Labor1ea1 to 3 h$185$0$185
Dishwasher Unit AllowanceLabor on: Dishwasher Hookup Labor1ea$0$500$500
Microwave Install Labor1ea2 to 5 h$160$0$160
Microwave Unit AllowanceLabor on: Microwave Install Labor1ea$0$250$250
Range Set and Connect1ea1 to 2 h$85$0$85
Range Unit AllowanceLabor on: Range Set and Connect1ea$0$700$700
Refrigerator Install Labor1ea1 to 2 h$85$0$85
Refrigerator Unit AllowanceLabor on: Refrigerator Install Labor1ea$0$900$900
Appliances subtotal6 to 9 h$2,865
Appliances subtotal6 to 9 h$2,865
Exterior
Exterior Caulking and Sealing Labor111.28lf2 to 5 h$161$0$161
Exterior Trim Install36lf1 to 4 h$153$0$153
House Wrap Install Labor1224sf6 to 14 h$441$0$441
House Wrap MaterialsLabor on: House Wrap Install Labor1346.4sf$0$565$565
Soffit and Fascia Install156lf14 to 30 h$1,014$0$1,014
Soffit and Fascia MaterialsLabor on: Soffit and Fascia Install171.6lf$0$1,459$1,459
Vinyl Siding Install Labor1032sf16 to 34 h$1,909$0$1,909
Vinyl Siding MaterialsLabor on: Vinyl Siding Install Labor1135.2sf$0$3,519$3,519
Exterior Window and Door Trim MaterialsLabor on: Exterior Trim Install36lf$0$117$117
Exterior subtotal50 to 75 h$9,338
Exterior subtotal50 to 75 h$9,338
Cleanup & Disposal
Construction Dumpster, per Haul3ea$0$0$1,950
Final Construction Clean (per sf)1050sf$0$0$473
Rough Clean, per Phase3ea12 to 49 h$2,100$0$2,100
Cleanup & Disposal subtotal12 to 49 h$4,523
Cleanup & Disposal subtotal12 to 49 h$4,523
General
Installation Supplies3ls$0$255$255
General subtotal$255
General subtotal$255
Roofing
Asphalt Shingle Install Labor13.8square14 to 30 h$2,484$0$2,484
Asphalt Shingle MaterialsLabor on: Asphalt Shingle Install Labor15.18square$0$2,657$2,657
Downspout Install Labor4ea1 to 5 h$220$0$220
Downspout MaterialsLabor on: Downspout Install Labor4ea$0$220$220
Drip Edge MaterialsLabor on: Asphalt Shingle Install Labor156.02lf$0$148$148
Gutter Install Labor85lf4 to 10 h$382$0$382
Gutter MaterialsLabor on: Gutter Install Labor93.5lf$0$514$514
Ice Water Shield Install Labor2.07square1 to 3 h$75$0$75
Ice Water Shield MaterialsLabor on: Ice Water Shield Install Labor2.07square$0$197$197
Ridge Vent Install Labor44.58lf1 to 2 h$87$0$87
Ridge Vent MaterialsLabor on: Ridge Vent Install Labor44.58lf$0$189$189
Synthetic Underlayment Install Labor13.8square2 to 6 h$414$0$414
Synthetic Underlayment Materials14.49square$0$319$319
Roofing subtotal30 to 48 h$7,906
Roofing subtotal30 to 48 h$7,906
Landscaping
Landscaping Allowance, New House1ea$0$3,000$3,000
Landscaping subtotal$3,000
Landscaping subtotal$3,000
DIRECT JOB COST1201 to 1423 h$185,602
DIRECT JOB COST1201 to 1423 h$185,602

B. 1,500 sf spec ranch, builder grade: $252,793

A builder-grade spec: three bedrooms and two baths on a slab, an attached two-car garage, vinyl siding, stock white shaker cabinets, a quartz kitchen with laminate vanity tops, fiberglass tub showers and LVP everywhere. Cover over the front door only, and no driveway was stated or priced. Labor is $98,988 of the $252,793 job cost, or 39.2%. It is about 1529 to 1817 hours of work, including setup, daily cleanup and material runs.

Labor cost by trade

Labor only. Materials, allowances and dump fees are in the line items below. Hours are person-hours at typical production from Clamp’s labor hours catalog, as a range: a planning figure, not a schedule and not a charge to the customer.

TradeHoursLabor costLean×1.25Standard×1.30Full-Service×1.40
Sitework11 to 20 h$1,346$1,683$1,750$1,885
Masonry70 to 141 h$6,694$8,368$8,702$9,372
Plumbing70 to 95 h$7,208$9,010$9,370$10,091
Electrical168 to 231 h$18,231$22,789$23,700$25,523
HVAC87 to 132 h$8,923$11,154$11,600$12,492
Drywall154 to 256 h$5,156$6,445$6,703$7,218
Carpentry293 to 380 h$23,288$29,110$30,274$32,603
Tile21 to 35 h$1,542$1,927$2,005$2,159
Flooring18 to 36 h$3,033$3,791$3,943$4,246
Painting103 to 142 h$7,056$8,820$9,173$9,878
Cabinets & Countertops7 to 17 h$750$937$975$1,050
Vanity & Fixtures7 to 16 h$980$1,225$1,274$1,372
Appliances6 to 9 h$515$644$669$721
Exterior76 to 115 h$5,749$7,186$7,474$8,049
Cleanup & Disposal12 to 49 h$2,100$2,625$2,730$2,940
Roofing51 to 82 h$6,417$8,021$8,342$8,984
Setup, cleanup and material runs109 to 328 hin the prices
All labor1529 to 1817 h$98,988$123,735$128,684$138,583

Every line item

Labor $98,988 + materials and allowances $115,427 + dump fees and other $38,378 = $252,793 direct job cost. Hours are person-hours at typical production, on labor rows only, and the direct-cost row adds about 15% for setup, daily cleanup and material runs; an allowance or material row names the labor line that installs it, and a subcontract row has none, because the sub’s price includes their own time. Some labor quantities include a difficulty factor, so they can exceed the measured area; each row’s derivation is in the downloadable data.

ItemQtyUnitHoursLaborMaterialLine cost
Sitework
Construction Entrance, Stabilized Stone1ea$0$0$2,400
Silt Fence Install Labor267lf4 to 9 h$374$0$374
Excavation Equipment Rental1day$0$0$550
Foundation Excavation (Machine, Per Cubic Yard)62.31cy$0$0$997
Portable Toilet Rental (per month)6month$0$0$1,350
Silt Fence Materials (per lf)Labor on: Silt Fence Install Labor293.7lf$0$250$250
Site Grading Labor4419sf5 to 12 h$972$0$972
Site Survey and Building Staking (per project)1ea$0$0$1,200
Temporary Power Monthly Service (per month)6month$0$0$990
Temporary Power or Water Hookup (One-Time)2ea$0$0$2,100
Utility Locate Service1ea$0$0$450
Sitework subtotal11 to 20 h$11,633
Sitework subtotal11 to 20 h$11,633
Masonry
Concrete Flatwork Install Labor2096sf65 to 136 h$6,498$0$6,498
Concrete Flatwork MaterialsLabor on: Concrete Flatwork Install Labor2305.6sf$0$12,104$12,104
Rigid Foam Insulation Board, Slab or Radiant Floor (per sf)Labor on: Under-Slab Rigid Insulation Lay (per sf)342.3sf$0$616$616
Slab Thickened Edge (per lf)235lf$0$0$4,935
Under-Slab Rigid Insulation Lay (per sf)326sf3 to 7 h$196$0$196
Under-Slab Vapor Retarder (per sf)2076sf$0$0$1,142
Masonry subtotal70 to 141 h$25,491
Masonry subtotal70 to 141 h$25,491
Plumbing
DWV Install Labor10lf3 to 7 h$360$0$360
Expansion TankLabor on: Expansion Tank Install Labor1ea$0$75$75
Expansion Tank Install Labor1ea1 to 2 h$110$0$110
Faucet Allowance (Kitchen, Utility or Outdoor)Labor on: Fixture Set Labor1ea$0$100$100
Kitchen Sink AllowanceLabor on: Fixture Set Labor1ea$0$360$360
Toilet AllowanceLabor on: Fixture Set Labor2ea$0$320$320
Fixture Set Labor7ea11 to 24 h$1,365$0$1,365
Hose Bib FixtureLabor on: Fixture Set Labor2ea$0$76$76
Kitchen Sink Trap and SuppliesLabor on: Fixture Set Labor1ea$0$45$45
DWV MaterialsLabor on: DWV Install Labor62.6lf$0$391$391
Plumbing Main Lines, New House (per sf)1500sf$0$0$6,375
Rough Plumbing ConsumablesLabor on: Plumbing Rough-In Per Fixture7ea$0$294$294
Plumbing Rough-In Per Fixture7ea18 to 38 h$2,800$0$2,800
Supply Pipe MaterialsLabor on: Supply Line Install Labor176.6lf$0$618$618
Sewer Cleanout AssemblyLabor on: Sewer Cleanout Install Labor1ea$0$95$95
Sewer Cleanout Install Labor1ea2 to 5 h$385$0$385
Sewer Lateral Install, Trenched and Backfilled (per lf)50lf$0$0$4,250
Shower Valve Trim AllowanceLabor on: Shower Valve Set and Trim Labor2ea$0$220$220
Shower Valve Set and Trim Labor2ea4 to 10 h$650$0$650
Shower Valve Rough-In BodyLabor on: Shower Valve Set and Trim Labor2ea$0$150$150
Shutoff Valve Install2ea1 to 2 h$116$0$116
Supply Line Install Labor28lf1 to 5 h$168$0$168
Toilet Setting MaterialsLabor on: Fixture Set Labor2ea$0$90$90
Alcove Tub Setting MaterialsLabor on: Fixture Set Labor2ea$0$130$130
Tub Unit AllowanceLabor on: Fixture Set Labor2ea$0$900$900
Tub Waste and Overflow KitLabor on: Fixture Set Labor2ea$0$130$130
Washer BoxLabor on: Washer Box Install Labor1ea$0$65$65
Washer Box Install Labor1ea1 to 3 h$230$0$230
Tank Water HeaterLabor on: Tank Water Heater Install1ea$0$750$750
Water Heater Connection KitLabor on: Tank Water Heater Install1ea$0$63$63
Tank Water Heater Install1ea1 to 4 h$297$0$297
Water Service Pipe Install Labor50lf2 to 6 h$212$0$212
Water Service Pipe MaterialsLabor on: Water Service Pipe Install Labor52.5lf$0$289$289
Water Service Pressure Test Labor1ea1 to 3 h$190$0$190
Water Service Trenching Labor50lf3 to 8 h$325$0$325
Plumbing subtotal70 to 95 h$22,994
Plumbing subtotal70 to 95 h$22,994
Electrical
Bath Fan Air Sealing Labor2eaunder 1 h$56$0$56
Bath Fan Duct Install Labor16lf1 to 2 h$76$0$76
Bath Fan Duct MaterialsLabor on: Bath Fan Duct Install Labor18.4lf$0$51$51
Bath Fan Electrical Hookup Labor2ea1 to 3 h$200$0$200
Bath Fan Termination Install Labor2ea1 to 4 h$220$0$220
Bath Fan Termination MaterialsLabor on: Bath Fan Termination Install Labor2ea$0$90$90
Bath Fan Housing Install Labor2ea2 to 6 h$380$0$380
Bath Fan Airflow Check2eaunder 1 h$60$0$60
Bathroom Exhaust Fan UnitLabor on: Bath Fan Housing Install Labor2ea$0$430$430
New Branch Circuit Install Labor (per circuit)20ea41 to 87 h$5,400$0$5,400
New Appliance Circuit Install Labor1ea2 to 5 h$275$0$275
Dedicated Circuit BreakerLabor on: New Branch Circuit Install Labor (per circuit)6ea$0$120$120
240V Outlet Install1ea1 to 4 h$235$0$235
Underground Electric Service Lateral (per lf)50lf$0$0$1,400
Electrical Box and Device MaterialsLabor on: Electrical Rough-In Per Device93ea$0$791$791
Electrical Rough ConsumablesLabor on: Electrical Rough-In Per Device25ea$0$163$163
Electrical Rough-In Per Device88ea34 to 72 h$3,696$0$3,696
GFCI Receptacle or AFCI Breaker Install8ea2 to 6 h$384$0$384
GFCI UnitLabor on: GFCI Receptacle or AFCI Breaker Install8ea$0$160$160
HVAC Condenser DisconnectLabor on: Air Source Heat Pump Install1ea$0$35$35
Light Fixture AllowanceLabor on: Light Fixture Install14ea$0$700$700
Light Fixture Install14ea7 to 17 h$1,190$0$1,190
Lighting DimmerLabor on: Outlet/Switch Install1ea$0$28$28
Meter SocketLabor on: Service Meter and Riser Install1ea$0$150$150
NM Cable 10/3 (30 A, 240 V)Labor on: New Branch Circuit Install Labor (per circuit)184lf$0$340$340
Outlet/Switch Install68ea11 to 23 h$2,040$0$2,040
Outlet UnitLabor on: Outlet/Switch Install47ea$0$135$135
Recessed Light (Can or Wafer)Labor on: Recessed Light Install Labor, Open Ceiling22ea$0$736$736
Recessed Light Install Labor, Open Ceiling22ea8 to 19 h$1,144$0$1,144
Romex Wire MaterialsLabor on: Electrical Rough-In Per Device2420.6lf$0$1,936$1,936
Service Meter and Riser Install1ea4 to 10 h$1,200$0$1,200
Service PanelLabor on: Service Panel Install Labor1ea$0$950$950
Service Panel Install Labor1ea5 to 13 h$1,450$0$1,450
Smoke and CO DetectorLabor on: Smoke/CO Detector Install5ea$0$275$275
Smoke/CO Detector Install5ea1 to 4 h$225$0$225
Switch UnitLabor on: Outlet/Switch Install23ea$0$56$56
Electrical subtotal168 to 231 h$26,777
Electrical subtotal168 to 231 h$26,777
HVAC
Exterior Vent Cap Install (Hood or Dryer)1ea1 to 3 h$195$0$195
Backup Strip HeatLabor on: Backup Strip Heat Install Labor1ea$0$275$275
Backup Strip Heat Install Labor1ea1 to 4 h$225$0$225
Condensate Drain Install1ea1 to 3 h$150$0$150
Dryer Vent Install Labor10lf1 to 3 h$165$0$165
Dryer Vent MaterialsLabor on: Dryer Vent Install Labor11lf$0$47$47
Dryer Vent Termination1ea$0$35$35
Ducted Heat Pump System Equipment (per system)Labor on: Air Source Heat Pump Install1ea$0$4,333$4,333
Ductwork Install292lf37 to 79 h$3,650$0$3,650
Ductwork MaterialsLabor on: Ductwork Install306.6lf$0$2,376$2,376
Air Source Heat Pump Install1ea14 to 31 h$2,850$0$2,850
HVAC Commissioning and Balance1ea1 to 5 h$340$0$340
HVAC Install Consumables1ea$0$285$285
HVAC Load Calculation Labor1ea2 to 6 h$340$0$340
Range Hood Duct Install Labor10lf1 to 4 h$95$0$95
Range Hood Duct MaterialsLabor on: Range Hood Duct Install Labor10lf$0$115$115
Refrigerant Line Set Install30lf1 to 4 h$255$0$255
Refrigerant Line MaterialsLabor on: Refrigerant Line Set Install34.5lf$0$293$293
Register BootLabor on: Ductwork Install17ea$0$544$544
Register and Grille Install17ea1 to 4 h$238$0$238
Return Duct Install Labor60lf2 to 6 h$330$0$330
Return Duct MaterialsLabor on: Return Duct Install Labor60lf$0$570$570
Standard Thermostat Install1ea1 to 2 h$90$0$90
Thermostat UnitLabor on: Standard Thermostat Install1ea$0$200$200
HVAC subtotal87 to 132 h$17,996
HVAC subtotal87 to 132 h$17,996
Insulation
Air Sealing Package, New Framing (per sf)1500sf$0$0$1,125
Attic Blown Insulation, Installed (per sf at R-49)1500sf$0$0$2,475
Wall Batt Insulation, Installed (per sf)1052sf$0$0$1,105
Insulation subtotal$4,705
Insulation subtotal$4,705
Drywall
Drywall Finish Labor5766sf76 to 159 h$2,768$0$2,768
Drywall Hang Labor5550sf54 to 113 h$2,276$0$2,276
Drywall Sheets MaterialsLabor on: Drywall Hang Labor6105sf$0$3,724$3,724
Type X Drywall Hang, Fire-Rated (per sf)216sf2 to 6 h$112$0$112
Type X Fire-Rated Drywall Materials (per sf)Labor on: Type X Drywall Hang, Fire-Rated (per sf)237.6sf$0$143$143
Drywall subtotal154 to 256 h$9,023
Drywall subtotal154 to 256 h$9,023
Carpentry
Bathroom Accessory AllowanceLabor on: Bathroom Accessory Install Labor6ea$0$150$150
Bathroom Accessory Install Labor6ea1 to 4 h$168$0$168
Closet System AllowanceLabor on: Closet System Install35.2lf$0$1,584$1,584
Closet System Install32lf4 to 9 h$672$0$672
Door Lock Hardware AllowanceLabor on: Exterior Door Install2ea$0$190$190
Door Unit AllowanceLabor on: Exterior Door Install2ea$0$1,540$1,540
Engineered Beam Material1ea$0$496$496
Exterior Door Install2ea4 to 10 h$1,000$0$1,000
Exterior Wall Framing MaterialsLabor on: Stud Wall Framing Install256.2lf$0$3,459$3,459
Fire-Rated Self-Closing Door Unit (each)Labor on: Interior Door Install1ea$0$475$475
Firestop at a Penetration (each)4ea1 to 3 h$96$0$96
Framing Fasteners and HardwareLabor on: Stud Wall Framing Install324lf$0$356$356
Header Installation1ea9 to 20 h$453$0$453
Sheathing Install4530sf35 to 74 h$4,983$0$4,983
Stud Wall Framing Install432lf56 to 117 h$4,320$0$4,320
Garage Door Install (per door)1ea6 to 14 h$595$0$595
Garage Door Opener (per opener)Labor on: Garage Door Opener Install Labor1ea$0$325$325
Garage Door Opener Install Labor1ea2 to 5 h$165$0$165
Garage Door Unit (per door)Labor on: Garage Door Install (per door)1ea$0$1,980$1,980
Interior Door Hardware AllowanceLabor on: Interior Door Install12ea$0$900$900
Interior Door Install12ea17 to 38 h$2,144$0$2,144
Interior Door AllowanceLabor on: Interior Door Install11ea$0$990$990
Partition Door Rough Opening11ea5 to 12 h$748$0$748
Porch Ceiling, Install Labor20sf1 to 2 h$105$0$105
Porch Ceiling MaterialLabor on: Porch Ceiling, Install Labor22sf$0$49$49
Porch Posts and Beam, Framing Labor7lf3 to 8 h$315$0$315
Porch Posts and Beam, MaterialsLabor on: Porch Posts and Beam, Framing Labor7lf$0$294$294
Roof Trusses and Roof Sheathing Materials (per roofing square)Labor on: Roof Truss Set and Brace (per roofing square)27.07square$0$13,129$13,129
Roof Truss Set and Brace (per roofing square)25.78square26 to 56 h$2,191$0$2,191
Base Shoe / Quarter Round Install22lfunder 1 h$30$0$30
Base Shoe / Quarter Round MaterialsLabor on: Base Shoe / Quarter Round Install24.2lf$0$30$30
Shower Curtain Rod AllowanceLabor on: Shower Curtain Rod Install Labor2ea$0$170$170
Shower Curtain Rod Install Labor2ea1 to 3 h$110$0$110
Stud Wall Framing MaterialsLabor on: Stud Wall Framing Install206.8lf$0$1,396$1,396
Baseboard and Casing Install682lf17 to 37 h$1,875$0$1,875
Trim MaterialsLabor on: Baseboard and Casing Install1124.2lf$0$2,361$2,361
Wall Sheathing MaterialsLabor on: Sheathing Install2147.2sf$0$2,040$2,040
Window Caulk and Flash MaterialsLabor on: Window Install14ea$0$672$672
Window and Door Install ConsumablesLabor on: Exterior Door Install2ea$0$96$96
Window Install14ea18 to 40 h$2,730$0$2,730
Window Stool and Apron Stock (per window)Labor on: Window Stool and Apron Install14ea$0$308$308
Window Stool and Apron Install14ea5 to 12 h$588$0$588
Window Unit AllowanceLabor on: Window Install14ea$0$4,200$4,200
Carpentry subtotal293 to 380 h$60,478
Carpentry subtotal293 to 380 h$60,478
Tile
Tile Grout Install Labor130sf2 to 6 h$228$0$228
Tile Grout MaterialsLabor on: Tile Grout Install Labor130sf$0$59$59
Bathroom Tile Install Labor130sf11 to 24 h$845$0$845
Floor Tile Material AllowanceLabor on: Bathroom Tile Install Labor143sf$0$358$358
Bath Tile Setting MaterialsLabor on: Bathroom Tile Install Labor143sf$0$122$122
Backsplash Tile Grout and Seal Labor25sfunder 1 h$11$0$11
Backsplash Tile Material AllowanceLabor on: Backsplash Tile Install Labor25sf$0$162$162
Backsplash Tile Setting MaterialsLabor on: Backsplash Tile Install Labor25sf$0$46$46
Uncoupling Membrane Labor130sf1 to 4 h$221$0$221
Uncoupling Membrane MaterialsLabor on: Uncoupling Membrane Labor130sf$0$318$318
Backsplash Tile Install Labor25sf2 to 5 h$237$0$237
Tile subtotal21 to 35 h$2,607
Tile subtotal21 to 35 h$2,607
Flooring
Floor Transition Install2ea1 to 2 h$80$0$80
Floor Transition MaterialsLabor on: Floor Transition Install7ea$0$245$245
Floor Underlayment Materials1330sf$0$731$731
Flooring Install Consumables2ea$0$170$170
LVP/LVT Install1330sf15 to 33 h$2,793$0$2,793
Door Threshold Transition Labor5ea1 to 4 h$160$0$160
LVP/LVT Material AllowanceLabor on: LVP/LVT Install1463sf$0$4,755$4,755
Flooring subtotal18 to 36 h$8,934
Flooring subtotal18 to 36 h$8,934
Painting
Interior Ceiling Paint Apply Labor1500sf9 to 20 h$840$0$840
Interior Door Paint (per door)11ea8 to 18 h$682$0$682
Interior Paint Apply Labor4080sf20 to 42 h$2,285$0$2,285
Paint Masking Setup Labor4080sf1 to 2 h$41$0$41
Premium Paint AllowanceLabor on: Interior Paint Apply Labor41.72gallon$0$2,003$2,003
Paint Prep Labor4200sf7 to 16 h$378$0$378
Paint Primer Application Labor5280.65sf11 to 24 h$1,162$0$1,162
Primer MaterialsLabor on: Paint Primer Application Labor17.54gallon$0$561$561
Paint Sundries Materials1ls$0$150$150
Trim Caulk and Filler MaterialsLabor on: Trim Paint Apply Labor1140lf$0$251$251
Trim Paint Apply Labor953lf22 to 46 h$1,668$0$1,668
Painting subtotal103 to 142 h$10,021
Painting subtotal103 to 142 h$10,021
Cabinets & Countertops
Cabinet Fillers, End Panels and Toe KickLabor on: Cabinet Install Labor12lf$0$300$300
Cabinet Hardware (per piece)32ea$0$80$80
Cabinet Install Fasteners and ShimsLabor on: Cabinet Install Labor20lf$0$45$45
Cabinet Install Labor20lf7 to 17 h$750$0$750
Cabinet Material AllowanceLabor on: Cabinet Install Labor20lf$0$3,600$3,600
Stone Countertop Fabrication40sf$0$0$1,120
Stone Countertop Install40sf$0$0$880
Stone Countertop Material AllowanceLabor on: Vanity Install Labor40sf$0$2,200$2,200
Cabinets & Countertops subtotal7 to 17 h$8,975
Cabinets & Countertops subtotal7 to 17 h$8,975
Vanity & Fixtures
Vanity Install Fasteners and Shims8lf$0$18$18
Bathroom Sink AllowanceLabor on: Fixture Set Labor2ea$0$180$180
Vanity Top, Laminate (per sf)Labor on: Vanity Install Labor15.2sf$0$182$182
Bathroom Faucet AllowanceLabor on: Fixture Set Labor2ea$0$180$180
Sink Trap and SuppliesLabor on: Fixture Set Labor2ea$0$90$90
Vanity Cabinet AllowanceLabor on: Vanity Install Labor8lf$0$1,040$1,040
Vanity Install Labor2ea6 to 14 h$850$0$850
Vanity Mirror or Medicine Cabinet (per unit)Labor on: Vanity Mirror Install (per unit)2ea$0$110$110
Vanity Mirror Install (per unit)2ea1 to 3 h$130$0$130
Vanity & Fixtures subtotal7 to 16 h$2,780
Vanity & Fixtures subtotal7 to 16 h$2,780
Appliances
Dishwasher Hookup Labor1ea1 to 3 h$185$0$185
Dishwasher Unit AllowanceLabor on: Dishwasher Hookup Labor1ea$0$500$500
Microwave Install Labor1ea2 to 5 h$160$0$160
Microwave Unit AllowanceLabor on: Microwave Install Labor1ea$0$250$250
Range Set and Connect1ea1 to 2 h$85$0$85
Range Unit AllowanceLabor on: Range Set and Connect1ea$0$700$700
Refrigerator Install Labor1ea1 to 2 h$85$0$85
Refrigerator Unit AllowanceLabor on: Refrigerator Install Labor1ea$0$900$900
Appliances subtotal6 to 9 h$2,865
Appliances subtotal6 to 9 h$2,865
Exterior
Exterior Caulking and Sealing Labor146.2lf3 to 7 h$212$0$212
Exterior Trim Install36lf1 to 4 h$153$0$153
House Wrap Install Labor2115sf11 to 23 h$761$0$761
House Wrap MaterialsLabor on: House Wrap Install Labor2326.5sf$0$977$977
Soffit and Fascia Install213lf19 to 40 h$1,384$0$1,384
Soffit and Fascia MaterialsLabor on: Soffit and Fascia Install234.3lf$0$1,992$1,992
Vinyl Siding Install Labor1751sf27 to 57 h$3,239$0$3,239
Vinyl Siding MaterialsLabor on: Vinyl Siding Install Labor1926.1sf$0$5,971$5,971
Exterior Window and Door Trim MaterialsLabor on: Exterior Trim Install36lf$0$117$117
Exterior subtotal76 to 115 h$14,806
Exterior subtotal76 to 115 h$14,806
Cleanup & Disposal
Construction Dumpster, per Haul4ea$0$0$2,600
Final Construction Clean (per sf)2076sf$0$0$934
Rough Clean, per Phase3ea12 to 49 h$2,100$0$2,100
Cleanup & Disposal subtotal12 to 49 h$5,634
Cleanup & Disposal subtotal12 to 49 h$5,634
General
Installation Supplies4ls$0$340$340
General subtotal$340
General subtotal$340
Roofing
Asphalt Shingle Install Labor25.78square26 to 56 h$4,640$0$4,640
Asphalt Shingle MaterialsLabor on: Asphalt Shingle Install Labor28.36square$0$4,963$4,963
Downspout Install Labor4ea1 to 5 h$220$0$220
Downspout MaterialsLabor on: Downspout Install Labor4ea$0$220$220
Drip Edge MaterialsLabor on: Asphalt Shingle Install Labor213.25lf$0$203$203
Gutter Install Labor117lf6 to 13 h$526$0$526
Gutter MaterialsLabor on: Gutter Install Labor128.7lf$0$708$708
Ice Water Shield Install Labor3.87square2 to 5 h$139$0$139
Ice Water Shield MaterialsLabor on: Ice Water Shield Install Labor3.87square$0$368$368
Ridge Vent Install Labor60.93lf1 to 3 h$119$0$119
Ridge Vent MaterialsLabor on: Ridge Vent Install Labor60.93lf$0$259$259
Synthetic Underlayment Install Labor25.78square5 to 11 h$773$0$773
Synthetic Underlayment Materials27.07square$0$596$596
Roofing subtotal51 to 82 h$13,734
Roofing subtotal51 to 82 h$13,734
Landscaping
Landscaping Allowance, New House1ea$0$3,000$3,000
Landscaping subtotal$3,000
Landscaping subtotal$3,000
DIRECT JOB COST1529 to 1817 h$252,793
DIRECT JOB COST1529 to 1817 h$252,793

C. 1,600 sf ranch, mid grade: $279,307

One finish tier up from the spec ranch: tiled and waterproofed baths, carpeted bedrooms, mid-grade windows, quartz counters, a 22x22 attached garage, a 6x10 covered porch and a 60 foot gravel driveway. Labor is $104,772 of the $279,307 job cost, or 37.5%. It is about 1635 to 1940 hours of work, including setup, daily cleanup and material runs.

Labor cost by trade

Labor only. Materials, allowances and dump fees are in the line items below. Hours are person-hours at typical production from Clamp’s labor hours catalog, as a range: a planning figure, not a schedule and not a charge to the customer.

TradeHoursLabor costLean×1.25Standard×1.30Full-Service×1.40
Sitework25 to 37 h$2,437$3,046$3,168$3,412
Masonry71 to 145 h$6,848$8,560$8,903$9,587
Plumbing70 to 95 h$7,208$9,010$9,370$10,091
Electrical174 to 239 h$18,841$23,551$24,493$26,378
HVAC87 to 133 h$8,961$11,201$11,649$12,546
Drywall164 to 272 h$5,528$6,910$7,186$7,739
Carpentry315 to 405 h$25,193$31,491$32,751$35,270
Tile36 to 61 h$2,543$3,179$3,306$3,560
Flooring21 to 36 h$2,654$3,318$3,450$3,716
Painting111 to 153 h$7,586$9,482$9,862$10,620
Cabinets & Countertops11 to 24 h$1,103$1,379$1,434$1,544
Vanity & Fixtures7 to 16 h$980$1,225$1,274$1,372
Appliances6 to 9 h$515$644$670$721
Exterior76 to 115 h$5,723$7,154$7,440$8,012
Cleanup & Disposal12 to 49 h$2,100$2,625$2,730$2,940
Roofing52 to 84 h$6,552$8,190$8,518$9,173
Setup, cleanup and material runs116 to 350 hin the prices
All labor1635 to 1940 h$104,772$130,965$136,204$146,681

Every line item

Labor $104,772 + materials and allowances $135,866 + dump fees and other $38,669 = $279,307 direct job cost. Hours are person-hours at typical production, on labor rows only, and the direct-cost row adds about 15% for setup, daily cleanup and material runs; an allowance or material row names the labor line that installs it, and a subcontract row has none, because the sub’s price includes their own time. Some labor quantities include a difficulty factor, so they can exceed the measured area; each row’s derivation is in the downloadable data.

ItemQtyUnitHoursLaborMaterialLine cost
Sitework
Compacted Gravel Base (per sf)720sf$0$979$979
Silt Fence Install Labor268lf4 to 9 h$375$0$375
Excavation Equipment Rental1day$0$0$550
Foundation Excavation (Machine, Per Cubic Yard)63.1cy$0$0$1,010
Gravel Base Spread and Compact Labor, Machine (per sf)720sf7 to 16 h$749$0$749
Driveway Crew Mobilization (per job)1ea2 to 6 h$325$0$325
Portable Toilet Rental (per month)6month$0$0$1,350
Silt Fence Materials (per lf)Labor on: Silt Fence Install Labor294.8lf$0$251$251
Site Grading Labor4489sf5 to 13 h$988$0$988
Site Survey and Building Staking (per project)1ea$0$0$1,200
Temporary Power Monthly Service (per month)6month$0$0$990
Temporary Power or Water Hookup (One-Time)2ea$0$0$2,100
Utility Locate Service1ea$0$0$450
Sitework subtotal25 to 37 h$11,317
Sitework subtotal25 to 37 h$11,317
Masonry
Concrete Flatwork Install Labor2144sf66 to 139 h$6,646$0$6,646
Concrete Flatwork MaterialsLabor on: Concrete Flatwork Install Labor2358.4sf$0$12,382$12,382
Rigid Foam Insulation Board, Slab or Radiant Floor (per sf)Labor on: Under-Slab Rigid Insulation Lay (per sf)352.8sf$0$635$635
Slab Thickened Edge (per lf)234lf$0$0$4,914
Under-Slab Rigid Insulation Lay (per sf)336sf3 to 7 h$202$0$202
Under-Slab Vapor Retarder (per sf)2084sf$0$0$1,146
Masonry subtotal71 to 145 h$25,925
Masonry subtotal71 to 145 h$25,925
Plumbing
Alcove Tub AllowanceLabor on: Fixture Set Labor2ea$0$1,100$1,100
DWV Install Labor10lf3 to 7 h$360$0$360
Expansion TankLabor on: Expansion Tank Install Labor1ea$0$75$75
Expansion Tank Install Labor1ea1 to 2 h$110$0$110
Faucet Allowance (Kitchen, Utility or Outdoor)Labor on: Fixture Set Labor1ea$0$225$225
Kitchen Sink AllowanceLabor on: Fixture Set Labor1ea$0$360$360
Toilet AllowanceLabor on: Fixture Set Labor2ea$0$650$650
Fixture Set Labor7ea11 to 24 h$1,365$0$1,365
Hose Bib FixtureLabor on: Fixture Set Labor2ea$0$76$76
Kitchen Sink Trap and SuppliesLabor on: Fixture Set Labor1ea$0$45$45
DWV MaterialsLabor on: DWV Install Labor62.6lf$0$391$391
Plumbing Main Lines, New House (per sf)1600sf$0$0$6,800
Rough Plumbing ConsumablesLabor on: Plumbing Rough-In Per Fixture7ea$0$294$294
Plumbing Rough-In Per Fixture7ea18 to 38 h$2,800$0$2,800
Supply Pipe MaterialsLabor on: Supply Line Install Labor176.6lf$0$618$618
Sewer Cleanout AssemblyLabor on: Sewer Cleanout Install Labor1ea$0$95$95
Sewer Cleanout Install Labor1ea2 to 5 h$385$0$385
Sewer Lateral Install, Trenched and Backfilled (per lf)50lf$0$0$4,250
Shower Valve Trim AllowanceLabor on: Shower Valve Set and Trim Labor2ea$0$520$520
Shower Valve Set and Trim Labor2ea4 to 10 h$650$0$650
Shower Valve Rough-In BodyLabor on: Shower Valve Set and Trim Labor2ea$0$330$330
Shutoff Valve Install2ea1 to 2 h$116$0$116
Supply Line Install Labor28lf1 to 5 h$168$0$168
Toilet Setting MaterialsLabor on: Fixture Set Labor2ea$0$90$90
Alcove Tub Setting MaterialsLabor on: Fixture Set Labor2ea$0$130$130
Tub Waste and Overflow KitLabor on: Fixture Set Labor2ea$0$130$130
Washer BoxLabor on: Washer Box Install Labor1ea$0$65$65
Washer Box Install Labor1ea1 to 3 h$230$0$230
Tank Water HeaterLabor on: Tank Water Heater Install1ea$0$750$750
Water Heater Connection KitLabor on: Tank Water Heater Install1ea$0$63$63
Tank Water Heater Install1ea1 to 4 h$297$0$297
Water Service Pipe Install Labor50lf2 to 6 h$212$0$212
Water Service Pipe MaterialsLabor on: Water Service Pipe Install Labor52.5lf$0$289$289
Water Service Pressure Test Labor1ea1 to 3 h$190$0$190
Water Service Trenching Labor50lf3 to 8 h$325$0$325
Plumbing subtotal70 to 95 h$24,554
Plumbing subtotal70 to 95 h$24,554
Electrical
Bath Fan Air Sealing Labor2eaunder 1 h$56$0$56
Bath Fan Duct Install Labor16lf1 to 2 h$76$0$76
Bath Fan Duct MaterialsLabor on: Bath Fan Duct Install Labor18.4lf$0$51$51
Bath Fan Electrical Hookup Labor2ea1 to 3 h$200$0$200
Bath Fan Termination Install Labor2ea1 to 4 h$220$0$220
Bath Fan Termination MaterialsLabor on: Bath Fan Termination Install Labor2ea$0$90$90
Bath Fan Housing Install Labor2ea2 to 6 h$380$0$380
Bath Fan Airflow Check2eaunder 1 h$60$0$60
Bathroom Exhaust Fan UnitLabor on: Bath Fan Housing Install Labor2ea$0$430$430
New Branch Circuit Install Labor (per circuit)21ea43 to 91 h$5,670$0$5,670
New Appliance Circuit Install Labor1ea2 to 5 h$275$0$275
Dedicated Circuit BreakerLabor on: New Branch Circuit Install Labor (per circuit)6ea$0$120$120
240V Outlet Install1ea1 to 4 h$235$0$235
Underground Electric Service Lateral (per lf)50lf$0$0$1,400
Electrical Box and Device MaterialsLabor on: Electrical Rough-In Per Device97ea$0$825$825
Electrical Rough ConsumablesLabor on: Electrical Rough-In Per Device26ea$0$169$169
Electrical Rough-In Per Device92ea35 to 75 h$3,864$0$3,864
GFCI Receptacle or AFCI Breaker Install8ea2 to 6 h$384$0$384
GFCI UnitLabor on: GFCI Receptacle or AFCI Breaker Install8ea$0$160$160
HVAC Condenser DisconnectLabor on: Air Source Heat Pump Install1ea$0$35$35
Light Fixture AllowanceLabor on: Light Fixture Install14ea$0$1,900$1,900
Light Fixture Install14ea7 to 17 h$1,190$0$1,190
Lighting DimmerLabor on: Outlet/Switch Install1ea$0$28$28
Meter SocketLabor on: Service Meter and Riser Install1ea$0$150$150
NM Cable 10/3 (30 A, 240 V)Labor on: New Branch Circuit Install Labor (per circuit)184lf$0$340$340
Outlet/Switch Install72ea11 to 25 h$2,160$0$2,160
Outlet UnitLabor on: Outlet/Switch Install49ea$0$220$220
Recessed Light (Can or Wafer)Labor on: Recessed Light Install Labor, Open Ceiling23ea$0$874$874
Recessed Light Install Labor, Open Ceiling23ea9 to 20 h$1,196$0$1,196
Romex Wire MaterialsLabor on: Electrical Rough-In Per Device2512.6lf$0$2,010$2,010
Service Meter and Riser Install1ea4 to 10 h$1,200$0$1,200
Service PanelLabor on: Service Panel Install Labor1ea$0$950$950
Service Panel Install Labor1ea5 to 13 h$1,450$0$1,450
Smoke and CO DetectorLabor on: Smoke/CO Detector Install5ea$0$275$275
Smoke/CO Detector Install5ea1 to 4 h$225$0$225
Switch UnitLabor on: Outlet/Switch Install25ea$0$112$112
Electrical subtotal174 to 239 h$28,980
Electrical subtotal174 to 239 h$28,980
HVAC
Exterior Vent Cap Install (Hood or Dryer)1ea1 to 3 h$195$0$195
Backup Strip HeatLabor on: Backup Strip Heat Install Labor1ea$0$275$275
Backup Strip Heat Install Labor1ea1 to 4 h$225$0$225
Condensate Drain Install1ea1 to 3 h$150$0$150
Dryer Vent Install Labor10lf1 to 3 h$165$0$165
Dryer Vent MaterialsLabor on: Dryer Vent Install Labor11lf$0$47$47
Dryer Vent Termination1ea$0$35$35
Ducted Heat Pump System Equipment (per system)Labor on: Air Source Heat Pump Install1ea$0$4,333$4,333
Ductwork Install295lf38 to 80 h$3,688$0$3,688
Ductwork MaterialsLabor on: Ductwork Install309.75lf$0$2,401$2,401
Air Source Heat Pump Install1ea14 to 31 h$2,850$0$2,850
HVAC Commissioning and Balance1ea1 to 5 h$340$0$340
HVAC Install Consumables1ea$0$285$285
HVAC Load Calculation Labor1ea2 to 6 h$340$0$340
Range Hood Duct Install Labor10lf1 to 4 h$95$0$95
Range Hood Duct MaterialsLabor on: Range Hood Duct Install Labor10lf$0$115$115
Refrigerant Line Set Install30lf1 to 4 h$255$0$255
Refrigerant Line MaterialsLabor on: Refrigerant Line Set Install34.5lf$0$293$293
Register BootLabor on: Ductwork Install17ea$0$544$544
Register and Grille Install17ea1 to 4 h$238$0$238
Return Duct Install Labor60lf2 to 6 h$330$0$330
Return Duct MaterialsLabor on: Return Duct Install Labor60lf$0$570$570
Standard Thermostat Install1ea1 to 2 h$90$0$90
Thermostat UnitLabor on: Standard Thermostat Install1ea$0$200$200
HVAC subtotal87 to 133 h$18,059
HVAC subtotal87 to 133 h$18,059
Insulation
Air Sealing Package, New Framing (per sf)1600sf$0$0$1,200
Attic Blown Insulation, Installed (per sf at R-49)1600sf$0$0$2,640
Wall Batt Insulation, Installed (per sf)1077sf$0$0$1,131
Insulation subtotal$4,971
Insulation subtotal$4,971
Drywall
Drywall Finish Labor6118sf81 to 169 h$2,998$0$2,998
Drywall Hang Labor5920sf57 to 120 h$2,427$0$2,427
Drywall Sheets MaterialsLabor on: Drywall Hang Labor6512sf$0$3,972$3,972
Type X Drywall Hang, Fire-Rated (per sf)198sf2 to 6 h$103$0$103
Type X Fire-Rated Drywall Materials (per sf)Labor on: Type X Drywall Hang, Fire-Rated (per sf)217.8sf$0$131$131
Drywall subtotal164 to 272 h$9,631
Drywall subtotal164 to 272 h$9,631
Carpentry
Bathroom Accessory AllowanceLabor on: Bathroom Accessory Install Labor6ea$0$288$288
Bathroom Accessory Install Labor6ea1 to 4 h$168$0$168
Closet System AllowanceLabor on: Closet System Install35.2lf$0$3,168$3,168
Closet System Install32lf8 to 18 h$1,344$0$1,344
Door Lock Hardware AllowanceLabor on: Exterior Door Install2ea$0$190$190
Door Unit AllowanceLabor on: Exterior Door Install2ea$0$2,200$2,200
Engineered Beam Material1ea$0$496$496
Exterior Door Install2ea4 to 10 h$1,000$0$1,000
Exterior Wall Framing MaterialsLabor on: Stud Wall Framing Install254.36lf$0$3,434$3,434
Fire-Rated Self-Closing Door Unit (each)Labor on: Interior Door Install1ea$0$475$475
Firestop at a Penetration (each)4ea1 to 3 h$96$0$96
Framing Fasteners and HardwareLabor on: Stud Wall Framing Install342lf$0$376$376
Header Installation1ea9 to 20 h$453$0$453
Sheathing Install4575sf35 to 75 h$5,032$0$5,032
Stud Wall Framing Install442.25lf57 to 120 h$4,422$0$4,422
Garage Door Install (per door)1ea6 to 14 h$595$0$595
Garage Door Opener (per opener)Labor on: Garage Door Opener Install Labor1ea$0$325$325
Garage Door Opener Install Labor1ea2 to 5 h$165$0$165
Garage Door Unit (per door)Labor on: Garage Door Install (per door)1ea$0$1,980$1,980
Interior Door Hardware AllowanceLabor on: Interior Door Install12ea$0$900$900
Interior Door Install12ea18 to 39 h$2,240$0$2,240
Interior Door AllowanceLabor on: Interior Door Install11ea$0$2,035$2,035
Partition Door Rough Opening11ea5 to 12 h$748$0$748
Porch Ceiling, Install Labor60sf2 to 5 h$315$0$315
Porch Ceiling MaterialLabor on: Porch Ceiling, Install Labor66sf$0$148$148
Porch Posts and Beam, Framing Labor12lf6 to 13 h$540$0$540
Porch Posts and Beam, MaterialsLabor on: Porch Posts and Beam, Framing Labor12lf$0$504$504
Roof Trusses and Roof Sheathing Materials (per roofing square)Labor on: Roof Truss Set and Brace (per roofing square)27.69square$0$13,430$13,430
Roof Truss Set and Brace (per roofing square)26.37square27 to 57 h$2,241$0$2,241
Base Shoe / Quarter Round Install23lfunder 1 h$31$0$31
Base Shoe / Quarter Round MaterialsLabor on: Base Shoe / Quarter Round Install25.3lf$0$32$32
Shower Curtain Rod AllowanceLabor on: Shower Curtain Rod Install Labor2ea$0$170$170
Shower Curtain Rod Install Labor2ea1 to 3 h$110$0$110
Stud Wall Framing MaterialsLabor on: Stud Wall Framing Install220lf$0$1,485$1,485
Baseboard and Casing Install729lf19 to 42 h$2,107$0$2,107
Trim MaterialsLabor on: Baseboard and Casing Install1175.9lf$0$3,069$3,069
Wall Sheathing MaterialsLabor on: Sheathing Install2131.8sf$0$2,025$2,025
Window Caulk and Flash MaterialsLabor on: Window Install15ea$0$720$720
Window and Door Install ConsumablesLabor on: Exterior Door Install2ea$0$96$96
Window Install15ea20 to 43 h$2,925$0$2,925
Window Stool and Apron Stock (per window)Labor on: Window Stool and Apron Install15ea$0$600$600
Window Stool and Apron Install15ea6 to 14 h$661$0$661
Window Unit AllowanceLabor on: Window Install15ea$0$4,500$4,500
Carpentry subtotal315 to 405 h$67,839
Carpentry subtotal315 to 405 h$67,839
Tile
Tile Grout Install Labor250sf5 to 12 h$438$0$438
Tile Grout MaterialsLabor on: Tile Grout Install Labor250sf$0$113$113
Bathroom Tile Install Labor250sf21 to 45 h$1,625$0$1,625
Floor Tile Material AllowanceLabor on: Bathroom Tile Install Labor143sf$0$644$644
Bath Tile Setting MaterialsLabor on: Bathroom Tile Install Labor275sf$0$234$234
Wall Tile Material AllowanceLabor on: Bathroom Tile Install Labor132sf$0$858$858
Shower Wall Foam Board, Sealant Seams (Wedi, GoBoard), Installed120sf$0$0$1,140
Backsplash Tile Grout and Seal Labor26sfunder 1 h$12$0$12
Backsplash Tile Material AllowanceLabor on: Backsplash Tile Install Labor26sf$0$169$169
Backsplash Tile Setting MaterialsLabor on: Backsplash Tile Install Labor26sf$0$48$48
Uncoupling Membrane Labor130sf1 to 4 h$221$0$221
Uncoupling Membrane MaterialsLabor on: Uncoupling Membrane Labor130sf$0$318$318
Backsplash Tile Install Labor26sf2 to 6 h$247$0$247
Tile subtotal36 to 61 h$6,067
Tile subtotal36 to 61 h$6,067
Flooring
Carpet Material AllowanceLabor on: Carpet Install495sf$0$1,609$1,609
Floor Transition Install2ea1 to 2 h$80$0$80
Floor Transition MaterialsLabor on: Floor Transition Install7ea$0$245$245
Floor Underlayment Materials978sf$0$538$538
Carpet Install450sf4 to 10 h$360$0$360
Flooring Install ConsumablesLabor on: Carpet Install3ea$0$255$255
LVP/LVT Install978sf11 to 24 h$2,054$0$2,054
Door Threshold Transition Labor5ea1 to 4 h$160$0$160
LVP/LVT Material AllowanceLabor on: LVP/LVT Install1075.8sf$0$3,496$3,496
Flooring subtotal21 to 36 h$8,797
Flooring subtotal21 to 36 h$8,797
Painting
Interior Ceiling Paint Apply Labor1600sf9 to 21 h$896$0$896
Interior Door Paint (per door)11ea9 to 19 h$716$0$716
Interior Paint Apply Labor4350sf21 to 45 h$2,436$0$2,436
Paint Masking Setup Labor4350sf1 to 2 h$43$0$43
Premium Paint AllowanceLabor on: Interior Paint Apply Labor44.21gallon$0$2,122$2,122
Paint Prep Labor4478sf8 to 17 h$403$0$403
Paint Primer Application Labor5639.25sf12 to 26 h$1,241$0$1,241
Primer MaterialsLabor on: Paint Primer Application Labor18.75gallon$0$600$600
Paint Sundries Materials1ls$0$150$150
Trim Caulk and Filler MaterialsLabor on: Trim Paint Apply Labor1193lf$0$262$262
Trim Paint Apply Labor1006lf24 to 51 h$1,851$0$1,851
Painting subtotal111 to 153 h$10,720
Painting subtotal111 to 153 h$10,720
Cabinets & Countertops
Cabinet Fillers, End Panels and Toe KickLabor on: Cabinet Install Labor12lf$0$660$660
Cabinet Hardware (per piece)34ea$0$221$221
Cabinet Install Fasteners and ShimsLabor on: Cabinet Install Labor21lf$0$47$47
Cabinet Install Labor21lf11 to 24 h$1,103$0$1,103
Cabinet Material AllowanceLabor on: Cabinet Install Labor21lf$0$7,560$7,560
Stone Countertop Fabrication42sf$0$0$1,176
Stone Countertop Install42sf$0$0$924
Stone Countertop Material AllowanceLabor on: Vanity Install Labor42sf$0$2,310$2,310
Cabinets & Countertops subtotal11 to 24 h$14,001
Cabinets & Countertops subtotal11 to 24 h$14,001
Vanity & Fixtures
Vanity Install Fasteners and Shims8lf$0$18$18
Bathroom Sink AllowanceLabor on: Fixture Set Labor2ea$0$450$450
Bathroom Faucet AllowanceLabor on: Fixture Set Labor2ea$0$400$400
Sink Trap and SuppliesLabor on: Fixture Set Labor2ea$0$90$90
Vanity Top Fabrication15.2sf$0$0$426
Vanity Top Install15.2sf$0$0$334
Vanity Top Material Allowance15.2sf$0$638$638
Vanity Cabinet AllowanceLabor on: Vanity Install Labor8lf$0$2,280$2,280
Vanity Install Labor2ea6 to 14 h$850$0$850
Vanity Mirror or Medicine Cabinet (per unit)Labor on: Vanity Mirror Install (per unit)2ea$0$300$300
Vanity Mirror Install (per unit)2ea1 to 3 h$130$0$130
Vanity & Fixtures subtotal7 to 16 h$5,916
Vanity & Fixtures subtotal7 to 16 h$5,916
Appliances
Dishwasher Hookup Labor1ea1 to 3 h$185$0$185
Dishwasher Unit AllowanceLabor on: Dishwasher Hookup Labor1ea$0$850$850
Microwave Install Labor1ea2 to 5 h$160$0$160
Microwave Unit AllowanceLabor on: Microwave Install Labor1ea$0$600$600
Range Set and Connect1ea1 to 2 h$85$0$85
Range Unit AllowanceLabor on: Range Set and Connect1ea$0$1,250$1,250
Refrigerator Install Labor1ea1 to 2 h$85$0$85
Refrigerator Unit AllowanceLabor on: Refrigerator Install Labor1ea$0$1,600$1,600
Appliances subtotal6 to 9 h$4,815
Appliances subtotal6 to 9 h$4,815
Exterior
Exterior Caulking and Sealing Labor146.92lf3 to 7 h$213$0$213
Exterior Trim Install36lf1 to 4 h$153$0$153
House Wrap Install Labor2106sf10 to 23 h$758$0$758
House Wrap MaterialsLabor on: House Wrap Install Labor2316.6sf$0$973$973
Soffit and Fascia Install216lf19 to 41 h$1,404$0$1,404
Soffit and Fascia MaterialsLabor on: Soffit and Fascia Install237.6lf$0$2,020$2,020
Vinyl Siding Install Labor1727sf26 to 56 h$3,195$0$3,195
Vinyl Siding MaterialsLabor on: Vinyl Siding Install Labor1899.7sf$0$5,889$5,889
Exterior Window and Door Trim MaterialsLabor on: Exterior Trim Install36lf$0$117$117
Exterior subtotal76 to 115 h$14,722
Exterior subtotal76 to 115 h$14,722
Cleanup & Disposal
Construction Dumpster, per Haul4ea$0$0$2,600
Final Construction Clean (per sf)2084sf$0$0$938
Rough Clean, per Phase3ea12 to 49 h$2,100$0$2,100
Cleanup & Disposal subtotal12 to 49 h$5,638
Cleanup & Disposal subtotal12 to 49 h$5,638
General
Installation Supplies4ls$0$340$340
General subtotal$340
General subtotal$340
Roofing
Asphalt Shingle Install Labor26.37square27 to 57 h$4,747$0$4,747
Asphalt Shingle MaterialsLabor on: Asphalt Shingle Install Labor29.01square$0$5,077$5,077
Downspout Install Labor4ea1 to 5 h$220$0$220
Downspout MaterialsLabor on: Downspout Install Labor4ea$0$220$220
Drip Edge MaterialsLabor on: Asphalt Shingle Install Labor215.68lf$0$205$205
Gutter Install Labor118lf6 to 13 h$531$0$531
Gutter MaterialsLabor on: Gutter Install Labor129.8lf$0$714$714
Ice Water Shield Install Labor3.96square2 to 5 h$143$0$143
Ice Water Shield MaterialsLabor on: Ice Water Shield Install Labor3.96square$0$376$376
Ridge Vent Install Labor61.62lf1 to 3 h$120$0$120
Ridge Vent MaterialsLabor on: Ridge Vent Install Labor61.62lf$0$262$262
Synthetic Underlayment Install Labor26.37square5 to 11 h$791$0$791
Synthetic Underlayment Materials27.69square$0$609$609
Roofing subtotal52 to 84 h$14,015
Roofing subtotal52 to 84 h$14,015
Landscaping
Landscaping Allowance, New House1ea$0$3,000$3,000
Landscaping subtotal$3,000
Landscaping subtotal$3,000
DIRECT JOB COST1635 to 1940 h$279,307
DIRECT JOB COST1635 to 1940 h$279,307

D. 2,400 sf two-story: $437,424

Four bedrooms and three baths over a full unfinished basement, a three-car garage, an 8x18 porch, fiber cement siding, a semi-custom quartz kitchen and gas heat. Labor is $174,369 of the $437,424 job cost, or 39.9%. It is about 2916 to 3450 hours of work, including setup, daily cleanup and material runs.

Labor cost by trade

Labor only. Materials, allowances and dump fees are in the line items below. Hours are person-hours at typical production from Clamp’s labor hours catalog, as a range: a planning figure, not a schedule and not a charge to the customer.

TradeHoursLabor costLean×1.25Standard×1.30Full-Service×1.40
Sitework19 to 30 h$2,023$2,529$2,630$2,832
Masonry286 to 456 h$17,645$22,056$22,939$24,703
Plumbing106 to 142 h$11,156$13,945$14,503$15,618
Electrical242 to 333 h$25,745$32,181$33,469$36,043
HVAC134 to 202 h$11,783$14,729$15,318$16,496
Insulation16 to 36 h$1,232$1,540$1,602$1,725
Drywall245 to 406 h$8,252$10,315$10,728$11,553
Carpentry666 to 824 h$50,235$62,794$65,305$70,329
Tile51 to 86 h$3,604$4,505$4,685$5,046
Flooring31 to 52 h$3,984$4,980$5,179$5,578
Painting162 to 223 h$11,128$13,910$14,466$15,579
Cabinets & Countertops14 to 30 h$1,365$1,706$1,774$1,911
Vanity & Fixtures11 to 23 h$1,470$1,837$1,911$2,058
Appliances6 to 9 h$515$644$669$721
Exterior195 to 301 h$15,532$19,415$20,192$21,745
Cleanup & Disposal12 to 49 h$2,100$2,625$2,730$2,940
Roofing52 to 84 h$6,600$8,250$8,580$9,240
Setup, cleanup and material runs207 to 623 hin the prices
All labor2916 to 3450 h$174,369$217,961$226,680$244,117

Every line item

Labor $174,369 + materials and allowances $206,714 + dump fees and other $56,341 = $437,424 direct job cost. Hours are person-hours at typical production, on labor rows only, and the direct-cost row adds about 15% for setup, daily cleanup and material runs; an allowance or material row names the labor line that installs it, and a subcontract row has none, because the sub’s price includes their own time. Some labor quantities include a difficulty factor, so they can exceed the measured area; each row’s derivation is in the downloadable data.

ItemQtyUnitHoursLaborMaterialLine cost
Sitework
Construction Entrance, Stabilized Stone1ea$0$0$2,400
Silt Fence Install Labor269lf4 to 9 h$377$0$377
Excavation Equipment Rental1day$0$0$550
Exterior Footing Drain (per lf)145lf$0$0$2,030
Wider Footing for Two-Story Loads, Added Labor (per lf)145lf5 to 12 h$653$0$653
Foundation Excavation (Machine, Per Cubic Yard)461.91cy$0$0$7,391
Portable Toilet Rental (per month)7month$0$0$1,575
Silt Fence Materials (per lf)Labor on: Silt Fence Install Labor295.9lf$0$252$252
Site Grading Labor4512sf5 to 13 h$993$0$993
Site Survey and Building Staking (per project)1ea$0$0$1,200
Temporary Power Monthly Service (per month)7month$0$0$1,155
Temporary Power or Water Hookup (One-Time)2ea$0$0$2,100
Utility Locate Service1ea$0$0$450
Sitework subtotal19 to 30 h$21,126
Sitework subtotal19 to 30 h$21,126
Masonry
Concrete Flatwork Install Labor2160sf67 to 140 h$6,696$0$6,696
Concrete Flatwork MaterialsLabor on: Concrete Flatwork Install Labor2376sf$0$12,474$12,474
Concrete Footing Install Labor243lf37 to 79 h$2,552$0$2,552
Concrete Footing MaterialsLabor on: Concrete Footing Install Labor267.3lf$0$3,876$3,876
Foundation Dampproofing, Spray Applied1015sf$0$0$1,269
Foundation Pour Labor37.32cy135 to 283 h$8,397$0$8,397
Foundation Pour MaterialsLabor on: Foundation Pour Labor41.05cy$0$11,699$11,699
Under-Slab Vapor Retarder (per sf)2016sf$0$0$1,109
Masonry subtotal286 to 456 h$48,072
Masonry subtotal286 to 456 h$48,072
Plumbing
Alcove Tub AllowanceLabor on: Fixture Set Labor3ea$0$1,650$1,650
DWV Install Labor10lf3 to 7 h$360$0$360
Expansion TankLabor on: Expansion Tank Install Labor1ea$0$75$75
Expansion Tank Install Labor1ea1 to 2 h$110$0$110
Faucet Allowance (Kitchen, Utility or Outdoor)Labor on: Fixture Set Labor1ea$0$225$225
Kitchen Sink AllowanceLabor on: Fixture Set Labor1ea$0$360$360
Toilet AllowanceLabor on: Fixture Set Labor3ea$0$975$975
Fixture Set Labor9ea14 to 31 h$1,755$0$1,755
Gas Appliance Set and Connect2ea2 to 6 h$370$0$370
Gas Line Install Labor50lf5 to 12 h$700$0$700
Gas Line MaterialsLabor on: Gas Line Install Labor55lf$0$467$467
Gas Pressure Test Labor1ea1 to 2 h$135$0$135
Natural Gas Service Line (per lf)50lf$0$0$1,400
Hose Bib FixtureLabor on: Fixture Set Labor2ea$0$76$76
Kitchen Sink Trap and SuppliesLabor on: Fixture Set Labor1ea$0$45$45
DWV MaterialsLabor on: DWV Install Labor82.4lf$0$515$515
Plumbing Main Lines, New House (per sf)2400sf$0$0$10,200
Rough Plumbing ConsumablesLabor on: Plumbing Rough-In Per Fixture10ea$0$420$420
Plumbing Rough-In Per Fixture10ea26 to 54 h$4,000$0$4,000
Supply Pipe MaterialsLabor on: Supply Line Install Labor242.6lf$0$849$849
Sewer Cleanout AssemblyLabor on: Sewer Cleanout Install Labor1ea$0$95$95
Sewer Cleanout Install Labor1ea2 to 5 h$385$0$385
Sewer Lateral Install, Trenched and Backfilled (per lf)50lf$0$0$4,250
Shower Valve Trim AllowanceLabor on: Shower Valve Set and Trim Labor3ea$0$780$780
Shower Valve Set and Trim Labor3ea6 to 15 h$975$0$975
Shower Valve Rough-In BodyLabor on: Shower Valve Set and Trim Labor3ea$0$495$495
Shutoff Valve Install2ea1 to 2 h$116$0$116
Sump Crock, New Basement (before the slab)1ea1 to 3 h$325$0$325
Sump Discharge Line (per lf)20lf$0$0$280
Sump Pump Install1ea2 to 6 h$375$0$375
Sump Pump UnitLabor on: Sump Pump Install1ea$0$280$280
Supply Line Install Labor28lf1 to 5 h$168$0$168
Toilet Setting MaterialsLabor on: Fixture Set Labor3ea$0$135$135
Alcove Tub Setting MaterialsLabor on: Fixture Set Labor3ea$0$195$195
Tub Waste and Overflow KitLabor on: Fixture Set Labor3ea$0$195$195
Washer BoxLabor on: Washer Box Install Labor1ea$0$65$65
Washer Box Install Labor1ea1 to 3 h$230$0$230
Tank Water HeaterLabor on: Tank Water Heater Install1ea$0$750$750
Water Heater Connection KitLabor on: Tank Water Heater Install1ea$0$105$105
Tank Water Heater Install1ea2 to 6 h$425$0$425
Water Service Pipe Install Labor50lf2 to 6 h$212$0$212
Water Service Pipe MaterialsLabor on: Water Service Pipe Install Labor52.5lf$0$289$289
Water Service Pressure Test Labor1ea1 to 3 h$190$0$190
Water Service Trenching Labor50lf3 to 8 h$325$0$325
Plumbing subtotal106 to 142 h$36,327
Plumbing subtotal106 to 142 h$36,327
Electrical
Bath Fan Air Sealing Labor3ea1 to 2 h$84$0$84
Bath Fan Duct Install Labor24lf1 to 3 h$114$0$114
Bath Fan Duct MaterialsLabor on: Bath Fan Duct Install Labor27.6lf$0$76$76
Bath Fan Electrical Hookup Labor3ea2 to 5 h$300$0$300
Bath Fan Termination Install Labor3ea2 to 6 h$330$0$330
Bath Fan Termination MaterialsLabor on: Bath Fan Termination Install Labor3ea$0$135$135
Bath Fan Housing Install Labor3ea4 to 9 h$570$0$570
Bath Fan Airflow Check3ea1 to 2 h$90$0$90
Bathroom Exhaust Fan UnitLabor on: Bath Fan Housing Install Labor3ea$0$645$645
New Branch Circuit Install Labor (per circuit)26ea54 to 113 h$7,020$0$7,020
New Appliance Circuit Install Labor1ea2 to 5 h$275$0$275
Dedicated Circuit BreakerLabor on: New Branch Circuit Install Labor (per circuit)7ea$0$132$132
240V Outlet Install1ea1 to 4 h$235$0$235
Underground Electric Service Lateral (per lf)50lf$0$0$1,400
Electrical Box and Device MaterialsLabor on: Electrical Rough-In Per Device151ea$0$1,284$1,284
Electrical Rough ConsumablesLabor on: Electrical Rough-In Per Device33ea$0$215$215
Electrical Rough-In Per Device145ea56 to 118 h$6,090$0$6,090
GFCI Receptacle or AFCI Breaker Install9ea2 to 7 h$432$0$432
GFCI UnitLabor on: GFCI Receptacle or AFCI Breaker Install9ea$0$180$180
HVAC Condenser Disconnect1ea$0$35$35
Light Fixture AllowanceLabor on: Light Fixture Install23ea$0$2,550$2,550
Light Fixture Install23ea12 to 27 h$1,955$0$1,955
Lighting DimmerLabor on: Outlet/Switch Install1ea$0$28$28
Meter SocketLabor on: Service Meter and Riser Install1ea$0$150$150
NM Cable 10/3 (30 A, 240 V)Labor on: New Branch Circuit Install Labor (per circuit)92lf$0$170$170
Outlet/Switch Install114ea18 to 39 h$3,420$0$3,420
Outlet UnitLabor on: Outlet/Switch Install80ea$0$360$360
Recessed Light (Can or Wafer)Labor on: Recessed Light Install Labor, Open Ceiling35ea$0$1,330$1,330
Recessed Light Install Labor, Open Ceiling35ea14 to 30 h$1,820$0$1,820
Romex Wire MaterialsLabor on: Electrical Rough-In Per Device4404.2lf$0$3,523$3,523
Service Meter and Riser Install1ea4 to 10 h$1,200$0$1,200
Service PanelLabor on: Service Panel Install Labor1ea$0$950$950
Service Panel Install Labor1ea5 to 13 h$1,450$0$1,450
Smoke and CO DetectorLabor on: Smoke/CO Detector Install8ea$0$440$440
Smoke/CO Detector Install8ea2 to 6 h$360$0$360
Switch UnitLabor on: Outlet/Switch Install37ea$0$166$166
Electrical subtotal242 to 333 h$39,514
Electrical subtotal242 to 333 h$39,514
HVAC
AC CondenserLabor on: AC Condenser Install1ea$0$2,933$2,933
AC Condenser Install1ea10 to 21 h$1,045$0$1,045
Air Handler or Furnace Coil Install1ea1 to 4 h$325$0$325
Exterior Vent Cap Install (Hood or Dryer)1ea1 to 3 h$195$0$195
Combustion Vent Install27lf7 to 15 h$864$0$864
Appliance Vent Pipe MaterialsLabor on: Combustion Vent Install29.7lf$0$431$431
Condensate Drain Install1ea1 to 3 h$150$0$150
Dryer Vent Install Labor10lf1 to 3 h$165$0$165
Dryer Vent MaterialsLabor on: Dryer Vent Install Labor11lf$0$47$47
Dryer Vent Termination1ea$0$35$35
Ductwork Install452lf58 to 123 h$5,650$0$5,650
Ductwork MaterialsLabor on: Ductwork Install474.6lf$0$3,678$3,678
Evaporator CoilLabor on: Air Handler or Furnace Coil Install1ea$0$800$800
Furnace Install Labor1ea13 to 28 h$1,479$0$1,479
Furnace UnitLabor on: Furnace Install Labor1ea$0$2,415$2,415
HVAC Commissioning and Balance1ea1 to 5 h$340$0$340
HVAC Install Consumables1ea$0$285$285
HVAC Load Calculation Labor1ea2 to 6 h$340$0$340
Range Hood Duct Install Labor10lf1 to 4 h$95$0$95
Range Hood Duct MaterialsLabor on: Range Hood Duct Install Labor10lf$0$115$115
Refrigerant Line Set Install30lf1 to 4 h$255$0$255
Refrigerant Line MaterialsLabor on: Refrigerant Line Set Install34.5lf$0$293$293
Register BootLabor on: Ductwork Install27ea$0$864$864
Register and Grille Install27ea2 to 7 h$378$0$378
Return Duct Install Labor75lf3 to 7 h$412$0$412
Return Duct MaterialsLabor on: Return Duct Install Labor75lf$0$712$712
Standard Thermostat Install1ea1 to 2 h$90$0$90
Thermostat UnitLabor on: Standard Thermostat Install1ea$0$200$200
HVAC subtotal134 to 202 h$24,591
HVAC subtotal134 to 202 h$24,591
Insulation
Air Sealing Package, New Framing (per sf)2400sf$0$0$1,800
Attic Blown Insulation, Installed (per sf at R-49)1200sf$0$0$1,980
Rim Joist Insulation Install (per lf)145lf16 to 36 h$1,232$0$1,232
Rim Joist Rigid Foam (per lf)Labor on: Rim Joist Insulation Install (per lf)145lf$0$232$232
Wall Batt Insulation, Installed (per sf)1948sf$0$0$2,045
Insulation subtotal16 to 36 h$7,289
Insulation subtotal16 to 36 h$7,289
Drywall
Drywall Finish Labor9137sf121 to 253 h$4,477$0$4,477
Drywall Hang Labor8880sf86 to 180 h$3,641$0$3,641
Drywall Sheets MaterialsLabor on: Drywall Hang Labor9768sf$0$5,958$5,958
Type X Drywall Hang, Fire-Rated (per sf)257sf3 to 7 h$134$0$134
Type X Fire-Rated Drywall Materials (per sf)Labor on: Type X Drywall Hang, Fire-Rated (per sf)282.7sf$0$170$170
Drywall subtotal245 to 406 h$14,380
Drywall subtotal245 to 406 h$14,380
Carpentry
Floor System Framing Labor2400sf78 to 162 h$8,400$0$8,400
Floor System Framing MaterialsLabor on: Floor System Framing Labor2520sf$0$11,340$11,340
Bathroom Accessory AllowanceLabor on: Bathroom Accessory Install Labor9ea$0$432$432
Bathroom Accessory Install Labor9ea2 to 5 h$252$0$252
Closet System AllowanceLabor on: Closet System Install44lf$0$3,960$3,960
Closet System Install40lf10 to 22 h$1,680$0$1,680
Door Lock Hardware AllowanceLabor on: Exterior Door Install2ea$0$190$190
Door Unit AllowanceLabor on: Exterior Door Install2ea$0$2,200$2,200
Engineered Beam Material2ea$0$788$788
Exterior Door Install2ea4 to 10 h$1,000$0$1,000
Exterior Wall Framing MaterialsLabor on: Stud Wall Framing Install406.09lf$0$5,482$5,482
Fire-Rated Self-Closing Door Unit (each)Labor on: Interior Door Install1ea$0$475$475
Firestop at a Penetration (each)4ea1 to 3 h$96$0$96
Framing Fasteners and HardwareLabor on: Stud Wall Framing Install510lf$0$561$561
Header Installation6ea27 to 58 h$1,360$0$1,360
Sheathing Install5896sf45 to 96 h$6,486$0$6,486
Stud Wall Framing Install686.75lf89 to 186 h$6,868$0$6,868
Garage Door Install (per door)2ea10 to 23 h$1,020$0$1,020
Garage Door Opener (per opener)Labor on: Garage Door Opener Install Labor2ea$0$650$650
Garage Door Opener Install Labor2ea4 to 10 h$330$0$330
Garage Door Unit (per door)Labor on: Garage Door Install (per door)2ea$0$3,080$3,080
Interior Door Hardware AllowanceLabor on: Interior Door Install15ea$0$1,125$1,125
Interior Door Install15ea23 to 49 h$2,791$0$2,791
Interior Door AllowanceLabor on: Interior Door Install14ea$0$2,590$2,590
Partition Door Rough Opening14ea6 to 15 h$952$0$952
Porch Ceiling, Install Labor144sf4 to 11 h$756$0$756
Porch Ceiling MaterialLabor on: Porch Ceiling, Install Labor158.4sf$0$356$356
Porch Posts and Beam, Framing Labor19lf9 to 21 h$855$0$855
Porch Posts and Beam, MaterialsLabor on: Porch Posts and Beam, Framing Labor19lf$0$798$798
Roof Trusses and Roof Sheathing Materials (per roofing square)Labor on: Roof Truss Set and Brace (per roofing square)27.9square$0$13,531$13,531
Roof Truss Set and Brace (per roofing square)26.57square27 to 58 h$2,258$0$2,258
Base Shoe / Quarter Round Install30lfunder 1 h$40$0$40
Base Shoe / Quarter Round MaterialsLabor on: Base Shoe / Quarter Round Install33lf$0$41$41
Shower Curtain Rod AllowanceLabor on: Shower Curtain Rod Install Labor3ea$0$255$255
Shower Curtain Rod Install Labor3ea1 to 4 h$165$0$165
Balustrade MaterialLabor on: Balustrade Install Labor24lf$0$432$432
Balustrade Install Labor24lf11 to 25 h$912$0$912
Stair Finish System Labor2ea14 to 30 h$1,560$0$1,560
Stair Finish System MaterialsLabor on: Stair Finish System Labor2ea$0$850$850
Handrail MaterialLabor on: Handrail Install Labor24lf$0$504$504
Handrail Install Labor24lf6 to 13 h$528$0$528
Newel Post MaterialLabor on: Newel Post Install Labor2ea$0$370$370
Newel Post Install Labor2ea3 to 7 h$400$0$400
Stair Riser Install Labor29ea7 to 16 h$725$0$725
Stair Riser MaterialLabor on: Stair Riser Install Labor29ea$0$348$348
Stair Stringer Fabrication6ea5 to 13 h$630$0$630
Stair Stringer MaterialsLabor on: Stair Stringer Fabrication6ea$0$510$510
Stair Tread Install Labor27ea17 to 37 h$1,755$0$1,755
Stair Tread MaterialLabor on: Stair Tread Install Labor27ea$0$890$890
Stud Wall Framing MaterialsLabor on: Stud Wall Framing Install330lf$0$2,227$2,227
Baseboard and Casing Install1092lf29 to 62 h$3,156$0$3,156
Trim MaterialsLabor on: Baseboard and Casing Install1677.2lf$0$4,428$4,428
Wall Sheathing MaterialsLabor on: Sheathing Install3562.9sf$0$3,385$3,385
Window Caulk and Flash MaterialsLabor on: Window Install22ea$0$1,056$1,056
Window and Door Install ConsumablesLabor on: Exterior Door Install2ea$0$96$96
Window Install22ea29 to 62 h$4,290$0$4,290
Window Stool and Apron Stock (per window)Labor on: Window Stool and Apron Install22ea$0$880$880
Window Stool and Apron Install22ea9 to 20 h$970$0$970
Window Unit AllowanceLabor on: Window Install22ea$0$6,600$6,600
Carpentry subtotal666 to 824 h$120,665
Carpentry subtotal666 to 824 h$120,665
Tile
Tile Grout Install Labor360sf7 to 17 h$630$0$630
Tile Grout MaterialsLabor on: Tile Grout Install Labor360sf$0$162$162
Bathroom Tile Install Labor360sf31 to 65 h$2,340$0$2,340
Floor Tile Material AllowanceLabor on: Bathroom Tile Install Labor198sf$0$891$891
Bath Tile Setting MaterialsLabor on: Bathroom Tile Install Labor396sf$0$337$337
Wall Tile Material AllowanceLabor on: Bathroom Tile Install Labor198sf$0$1,287$1,287
Shower Wall Foam Board, Sealant Seams (Wedi, GoBoard), Installed180sf$0$0$1,710
Backsplash Tile Grout and Seal Labor33sfunder 1 h$15$0$15
Backsplash Tile Material AllowanceLabor on: Backsplash Tile Install Labor33sf$0$214$214
Backsplash Tile Setting MaterialsLabor on: Backsplash Tile Install Labor33sf$0$61$61
Uncoupling Membrane Labor180sf2 to 5 h$306$0$306
Uncoupling Membrane MaterialsLabor on: Uncoupling Membrane Labor180sf$0$441$441
Backsplash Tile Install Labor33sf3 to 7 h$313$0$313
Tile subtotal51 to 86 h$8,707
Tile subtotal51 to 86 h$8,707
Flooring
Carpet Material AllowanceLabor on: Carpet Install739.2sf$0$2,402$2,402
Floor Transition Install2ea1 to 2 h$80$0$80
Floor Transition MaterialsLabor on: Floor Transition Install9ea$0$315$315
Floor Underlayment Materials1496sf$0$823$823
Carpet Install672sf6 to 15 h$538$0$538
Flooring Install ConsumablesLabor on: Carpet Install3ea$0$255$255
LVP/LVT Install1496sf17 to 36 h$3,142$0$3,142
Door Threshold Transition Labor7ea2 to 5 h$224$0$224
LVP/LVT Material AllowanceLabor on: LVP/LVT Install1645.6sf$0$5,348$5,348
Flooring subtotal31 to 52 h$13,127
Flooring subtotal31 to 52 h$13,127
Painting
Interior Ceiling Paint Apply Labor2400sf14 to 31 h$1,344$0$1,344
Interior Door Paint (per door)14ea11 to 24 h$911$0$911
Interior Paint Apply Labor6510sf32 to 67 h$3,646$0$3,646
Paint Masking Setup Labor6510sf1 to 2 h$65$0$65
Premium Paint AllowanceLabor on: Interior Paint Apply Labor65.24gallon$0$3,132$3,132
Paint Prep Labor6702sf11 to 25 h$603$0$603
Paint Primer Application Labor8496.15sf18 to 39 h$1,869$0$1,869
Primer MaterialsLabor on: Paint Primer Application Labor28.25gallon$0$904$904
Paint Sundries Materials1ls$0$150$150
Trim Caulk and Filler MaterialsLabor on: Trim Paint Apply Labor1700lf$0$374$374
Trim Paint Apply Labor1462lf35 to 74 h$2,690$0$2,690
Painting subtotal162 to 223 h$15,688
Painting subtotal162 to 223 h$15,688
Cabinets & Countertops
Cabinet Fillers, End Panels and Toe KickLabor on: Cabinet Install Labor12lf$0$660$660
Cabinet Hardware (per piece)42ea$0$273$273
Cabinet Install Fasteners and ShimsLabor on: Cabinet Install Labor26lf$0$59$59
Cabinet Install Labor26lf14 to 30 h$1,365$0$1,365
Cabinet Material AllowanceLabor on: Cabinet Install Labor26lf$0$9,360$9,360
Stone Countertop Fabrication52sf$0$0$1,456
Stone Countertop Install52sf$0$0$1,144
Stone Countertop Material AllowanceLabor on: Vanity Install Labor52sf$0$2,860$2,860
Cabinets & Countertops subtotal14 to 30 h$17,177
Cabinets & Countertops subtotal14 to 30 h$17,177
Vanity & Fixtures
Vanity Install Fasteners and Shims11lf$0$25$25
Bathroom Sink AllowanceLabor on: Fixture Set Labor3ea$0$675$675
Vanity Top, Laminate (per sf)Labor on: Vanity Install Labor20.9sf$0$418$418
Bathroom Faucet AllowanceLabor on: Fixture Set Labor3ea$0$600$600
Sink Trap and SuppliesLabor on: Fixture Set Labor3ea$0$135$135
Vanity Cabinet AllowanceLabor on: Vanity Install Labor11lf$0$3,135$3,135
Vanity Install Labor3ea9 to 21 h$1,275$0$1,275
Vanity Mirror or Medicine Cabinet (per unit)Labor on: Vanity Mirror Install (per unit)3ea$0$450$450
Vanity Mirror Install (per unit)3ea1 to 4 h$195$0$195
Vanity & Fixtures subtotal11 to 23 h$6,908
Vanity & Fixtures subtotal11 to 23 h$6,908
Appliances
Dishwasher Hookup Labor1ea1 to 3 h$185$0$185
Dishwasher Unit AllowanceLabor on: Dishwasher Hookup Labor1ea$0$850$850
Microwave Install Labor1ea2 to 5 h$160$0$160
Microwave Unit AllowanceLabor on: Microwave Install Labor1ea$0$600$600
Range Set and Connect1ea1 to 2 h$85$0$85
Range Unit AllowanceLabor on: Range Set and Connect1ea$0$1,250$1,250
Refrigerator Install Labor1ea1 to 2 h$85$0$85
Refrigerator Unit AllowanceLabor on: Refrigerator Install Labor1ea$0$1,600$1,600
Appliances subtotal6 to 9 h$4,815
Appliances subtotal6 to 9 h$4,815
Exterior
Exterior Caulking and Sealing Labor172.48lf3 to 8 h$250$0$250
Exterior Trim Materials, Fiber CementLabor on: Exterior Trim Install780.18lf$0$2,536$2,536
Exterior Trim Install709.25lf32 to 67 h$3,014$0$3,014
Fiber Cement Siding Install Labor2837sf88 to 184 h$9,646$0$9,646
Fiber Cement Siding MaterialLabor on: Fiber Cement Siding Install Labor3120.7sf$0$10,298$10,298
House Wrap Install Labor3384sf17 to 37 h$1,218$0$1,218
House Wrap MaterialsLabor on: House Wrap Install Labor3722.4sf$0$1,563$1,563
Siding Staging Rental4week$0$0$3,400
Soffit and Fascia Install216lf19 to 41 h$1,404$0$1,404
Soffit and Fascia MaterialsLabor on: Soffit and Fascia Install237.6lf$0$2,020$2,020
Exterior subtotal195 to 301 h$35,349
Exterior subtotal195 to 301 h$35,349
Cleanup & Disposal
Construction Dumpster, per Haul4ea$0$0$2,600
Final Construction Clean (per sf)3216sf$0$0$1,447
Rough Clean, per Phase3ea12 to 49 h$2,100$0$2,100
Cleanup & Disposal subtotal12 to 49 h$6,147
Cleanup & Disposal subtotal12 to 49 h$6,147
General
Installation Supplies5ls$0$425$425
General subtotal$425
General subtotal$425
Roofing
Asphalt Shingle Install Labor26.57square27 to 58 h$4,783$0$4,783
Asphalt Shingle MaterialsLabor on: Asphalt Shingle Install Labor29.23square$0$5,115$5,115
Downspout Install Labor4ea1 to 5 h$220$0$220
Downspout MaterialsLabor on: Downspout Install Labor4ea$0$220$220
Drip Edge MaterialsLabor on: Asphalt Shingle Install Labor216.49lf$0$206$206
Gutter Install Labor119lf6 to 13 h$535$0$535
Gutter MaterialsLabor on: Gutter Install Labor130.9lf$0$720$720
Ice Water Shield Install Labor3.99square2 to 5 h$144$0$144
Ice Water Shield MaterialsLabor on: Ice Water Shield Install Labor3.99square$0$379$379
Ridge Vent Install Labor61.86lf1 to 3 h$121$0$121
Ridge Vent MaterialsLabor on: Ridge Vent Install Labor61.86lf$0$263$263
Synthetic Underlayment Install Labor26.57square5 to 11 h$797$0$797
Synthetic Underlayment Materials27.9square$0$614$614
Roofing subtotal52 to 84 h$14,117
Roofing subtotal52 to 84 h$14,117
Landscaping
Landscaping Allowance, New House1ea$0$3,000$3,000
Landscaping subtotal$3,000
Landscaping subtotal$3,000
DIRECT JOB COST2916 to 3450 h$437,424
DIRECT JOB COST2916 to 3450 h$437,424

Methodology & reproducibility

4 snapshots, one per build. Each build is frozen from its own estimate run with the same old work, system type and takeoff pinned, so the builds differ only in what is being built.

Direct cost equals the sum of each row’s rounded quantity × (labor + material + other). Amounts are shown in whole dollars; every column adds to its total.

Scope selection, prose accuracy, arithmetic and provenance mapping reviewed; not independent market-rate verification.

Questions

How much does it cost to build a house in 2026?

In these four builds, direct job cost runs from $185,602 for a 1,050 sf two-bedroom cottage to $437,424 for a 2,400 sf four-bedroom two-story over a full unfinished basement. That is about $169 to $182 per finished square foot before land, permits and the builder's markup.

What is the cost per square foot?

About $177 for the 1,050 sf cottage, $169 for the 1,500 sf ranch, $175 for the 1,600 sf ranch and $182 for the 2,400 sf two-story, computed from each build's direct job cost over its finished area. Small houses carry the kitchen, baths and mechanicals over fewer feet, which is why the cottage is not the cheapest per foot.

What is the difference between the 1,500 and 1,600 sf ranches?

$26,514, which is one finish tier plus 100 feet and the site items. The 1,500 sf build is a builder-grade spec: LVP everywhere, fiberglass tub showers, cover over the front door only, and no driveway was stated or priced. The 1,600 sf build is mid grade: tiled and waterproofed baths, carpeted bedrooms, mid-grade windows, a 6x10 covered porch and a 60 foot gravel driveway.

Why is the two-story the most expensive per square foot?

The 2,400 sf build carries a full unfinished basement, a three-car garage, a third bath, fiber cement siding and a gas furnace, water heater and service line. Those add cost without adding finished feet.

What markup do builders actually use?

Lower than remodelers. NAHB's average builder ran a 20.7% gross margin with 8.7% net profit in its latest study, and Markup & Profit's published new-home range is 21 to 29% plus gross margin. Those convert to markups of about 26% to 41% on job cost, which is why this page illustrates 25% to 40% instead of remodeling markups.

What do these numbers leave out?

The lot, financing, permit, impact and tap fees, builder's risk insurance, a warranty reserve, and the builder's overhead and profit. Direct job cost is what the work costs to perform; the markup table shows illustrative selling prices.

How much of a new house is labor?

Labor runs $75,965 on the cottage, $98,990 on the 1,500 sf ranch, $104,773 on the 1,600 sf ranch and $174,369 on the two-story, with subcontract and materials priced on their own lines.

Related

Sources & provenance

  1. Builders' Profit Margins Improved in 2023 (Cost of Doing Business Study, 2025 Edition) National Association of Home Builders (research)
  2. Markup & Profit: A Contractor's Guide, Revisited Michael C. Stone (book)
  3. 1,050 sf cottage reviewed snapshot Clamp Research
  4. 1,500 sf spec ranch, builder grade reviewed snapshot Clamp Research
  5. 1,600 sf ranch, mid grade reviewed snapshot Clamp Research
  6. 2,400 sf two-story reviewed snapshot Clamp Research
Changes: Oct 11, 2026: Initial publication: reviewed snapshots frozen from saved estimate runs, priced on the current baseline.; Oct 11, 2026: Markup illustrations changed to builder markups of 25% to 40%, from NAHB and Markup & Profit new-home margins.; Oct 11, 2026: Builder-grade vs mid-grade labels on the two ranches, with the difference itemized; line items open with trade subtotals and hours.; Oct 15, 2026: Drywall repriced at new-construction rates (hang $0.41, Level 4 finish $0.49, board with supplies $0.61 per sq ft); every other line is unchanged. v2 snapshots; v1 stays published.; Nov 10, 2026: Search Console pass: the title and the summary carry the price range the answer gives. No job cost changed.; Nov 10, 2026: Repriced at the November 2026 catalog from the same four saved estimate runs. Tiled baths are built with foam board shower walls and an uncoupling membrane, vanity tops are priced apart from kitchen countertops, and lighting, drain labor and the engineered beam are counted differently. Direct job cost runs $185,602 to $437,424 (was $187,321 to $442,718).
