Project cost · modeled example

Dishwasher Leak Floor Repair Cost (2026): $4,393 to $6,758

Replacing a leak-damaged kitchen floor and resetting the dishwasher costs about $4,393 to $6,758. A dishwasher leak that ruined 45 sq ft of engineered wood, fixed by replacing 240 sq ft of continuous floor with LVP and resetting the homeowner's new dishwasher, itemized with crew hours.

Direct answer: Replacing a leak-damaged kitchen floor and resetting the dishwasher costs about $4,393 to $6,758, from a direct job cost of $3,379 for this repair. Direct job cost is labor and materials only, with no contractor overhead or profit, and is not a price: no contractor performs work at job cost. Permit and inspection fees are not included.

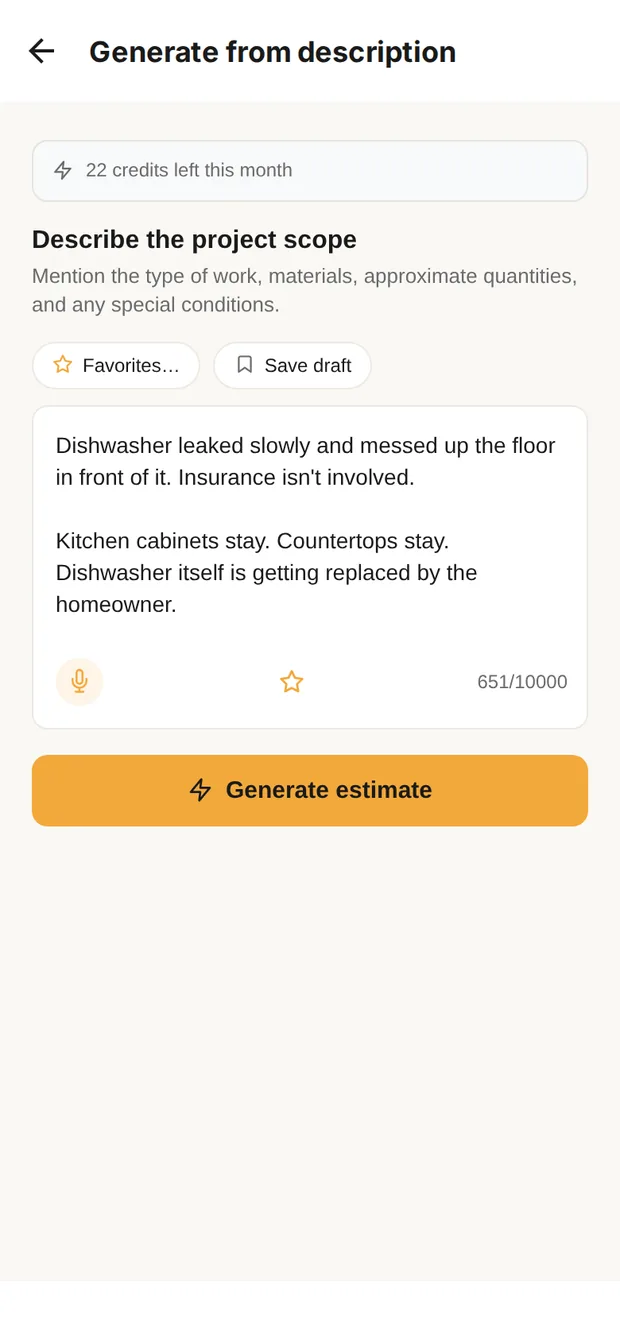

Clamp's Generate from description screen with the floor repair described in plain words

Describe it

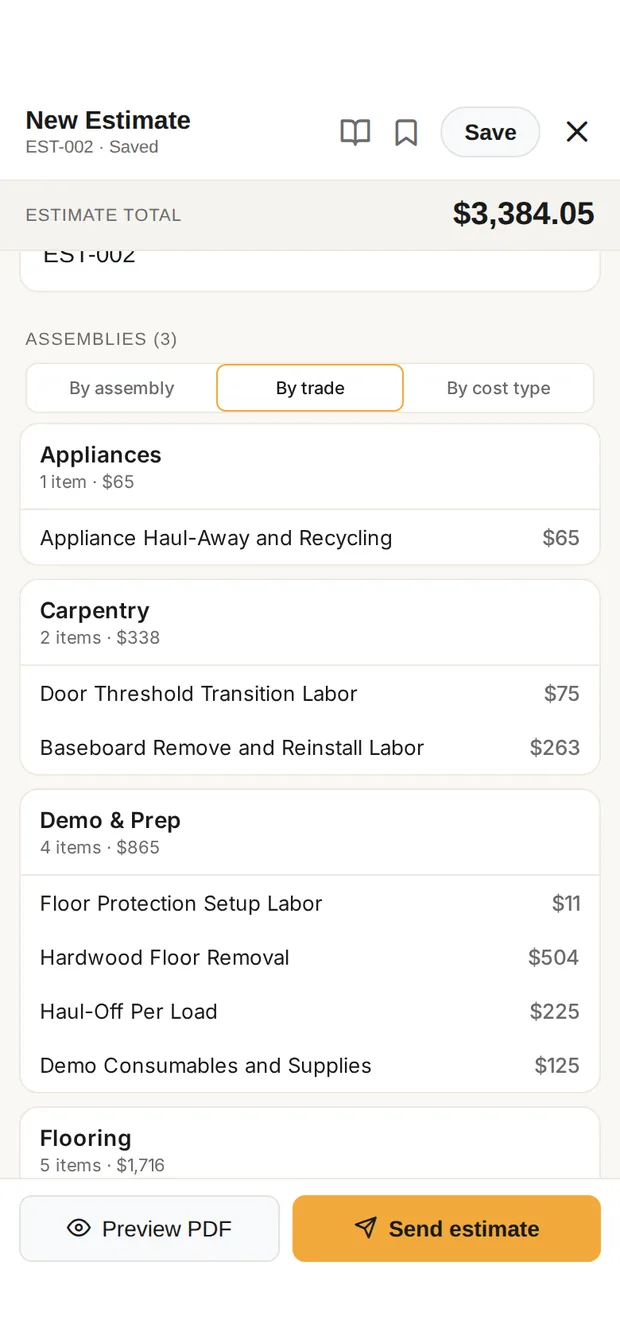

The estimate for the floor repair in Clamp's builder: total $3,379.05, grouped by trade

Every line, by trade

The job in the Clamp app: described in plain words, then the estimate at $3,379.05 job cost, every line grouped by trade. Sample data. Illustration of the Clamp app.

The job at a glance

One build, fully itemized, with crew hours.

BuildJob costLaborCrew hoursMaterialsIllustrative selling price
A. 240 sq ft of LVP, dishwasher reset$3,379$1,79319 to 27 h$1,301$4,393 to
$6,758

Dump fees and other costs ($285) are the same in every build and included in the job cost. Materials include allowances. Illustrative selling price is the job cost at a 30% to 100% markup; your price depends on your own overhead and profit. Labor hours are a planning range and include setup, daily cleanup and material runs; they are never a charge to the customer. Permit and inspection fees are not included; requirements vary by jurisdiction.

Which price is closer to yours?

  • Lean, +30%: A handyman or owner-operator who does the work with a small crew and no office. Usually the lowest quote. The owner handles scheduling, questions and callbacks around the work itself.
  • Standard, +50%: A remodeling company with a crew, an office, insurance and someone to answer the phone. Close to the average remodeler's overhead in the National Association of Home Builders cost-of-doing-business survey.
  • Full-Service, +100%: A design-build firm with designers, a salesperson and a project manager who runs the job. The extra pays for planning, coordination and one point of contact from design to final inspection.

Higher markup means more business behind the job, not by itself better work, and a lower markup is not by itself a better deal. For contractors: how each markup splits into overhead and profit is in the overhead categories guide.

The build in detail

A. 240 sq ft of LVP, dishwasher reset: $3,379

The old dishwasher comes out and the floor underneath is inspected; 240 sq ft of engineered wood is removed through the kitchen and breakfast area; new LVP goes down over underlayment; base molding is reset and the homeowner's new dishwasher goes in. Labor is $1,793 of the $3,379 job cost, or 53.1%. It is about 19 to 27 hours of work, including setup, daily cleanup and material runs.

Labor cost by trade

Labor only. Materials, allowances and dump fees are in the line items below. Hours are person-hours at typical production from Clamp’s labor hours catalog, as a range: a planning figure, not a schedule and not a charge to the customer.

TradeHoursLabor costLean×1.30Standard×1.50Full-Service×2.00
Demo & Prep4 to 9 h$515$670$773$1,030
Carpentry2 to 7 h$263$342$395$526
Flooring4 to 9 h$615$799$922$1,230
Appliances2 to 4 h$400$520$600$800
Setup, cleanup and material runs1 to 5 hin the prices
All labor19 to 27 h$1,793$2,331$2,690$3,586

Every line item

Labor $1,793 + materials and allowances $1,301 + dump fees and other $285 = $3,379 direct job cost. Hours are person-hours at typical production, on labor rows only, and the direct-cost row adds about 15% for setup, daily cleanup and material runs; an allowance or material row names the labor line that installs it, and a subcontract row has none, because the sub’s price includes their own time. Some labor quantities include a difficulty factor, so they can exceed the measured area; each row’s derivation is in the downloadable data.

ItemQtyUnitHoursLaborMaterialLine cost
Demo & Prep
Demo Consumables and Supplies1ls$0$125$125
Hardwood Floor Removal240sf3 to 9 h$504$0$504
Debris Haul-Off (per Load)1ea$0$0$225
Floor Protection Labor, Access Path Through the House24sfunder 1 h$11$0$11
Demo & Prep subtotal4 to 9 h$865
Demo & Prep subtotal4 to 9 h$865
Carpentry
Baseboard Remove and Reinstall Labor81lf2 to 7 h$263$0$263
Carpentry subtotal2 to 7 h$263
Carpentry subtotal2 to 7 h$263
Flooring
Floor Transition MaterialsLabor on: Door Threshold Transition Labor1ea$0$35$35
Floor Underlayment Materials240sf$0$132$132
Flooring Install Consumables1ea$0$85$85
LVP/LVT Install240sf3 to 9 h$540$0$540
Door Threshold Transition Labor1eaunder 1 h$75$0$75
LVP/LVT Material AllowanceLabor on: LVP/LVT Install264sf$0$924$924
Flooring subtotal4 to 9 h$1,791
Flooring subtotal4 to 9 h$1,791
Appliances
Dishwasher Install Labor1ea1 to 3 h$275$0$275
Existing Dishwasher Removal Labor1eaunder 1 h$125$0$125
Appliances subtotal2 to 4 h$400
Appliances subtotal2 to 4 h$400
Cleanup & Disposal
Appliance Haul-Away and Recycling1ea$0$0$60
Cleanup & Disposal subtotal$60
Cleanup & Disposal subtotal$60
DIRECT JOB COST19 to 27 h$3,379
DIRECT JOB COST19 to 27 h$3,379

Methodology & reproducibility

One reviewed snapshot for this build. The build is frozen from its own estimate run and priced by the published pricer.

Direct cost equals the sum of each row’s rounded quantity × (labor + material + other). Amounts are shown in whole dollars; every column adds to its total.

Scope selection, prose accuracy, arithmetic and provenance mapping reviewed; not independent market-rate verification.

Questions

Why replace 240 sq ft when 45 sq ft is damaged?

The floor runs continuously into the breakfast area, so a patch would show. Replacing the whole run to a natural break is what keeps it from looking repaired.

What can push this job higher?

A soft subfloor once the flooring is up, which is a separate line when it is found; mold; or cabinets that sit on the old floor and have to be worked around.

Is the markup on top of this?

Yes. Direct job cost is what the repair costs a contractor to perform. The markup table shows what it sells for at illustrative markups of 30% to 100%.

Related

Sources & provenance

  1. 240 sq ft of LVP, dishwasher reset reviewed snapshot Clamp Research
Changes: Oct 12, 2026: Initial publication: reviewed snapshot frozen from a saved estimate run, priced on the current baseline.; Nov 10, 2026: Search Console pass: the title and the summary carry the price range the answer gives. No job cost changed.; Nov 10, 2026: Repriced at the November 2026 catalog from the same saved estimate run. Appliance haul-away is $60 (was $65). Direct job cost $3,379 (was $3,385).
