Project cost · modeled example

Gas Water Heater Replacement Cost (2026): $3,128 to $4,812

Replacing a 50-gallon gas water heater like for like costs about $3,128 to $4,812. A leaking 50-gallon gas tank replaced like for like in a basement: removal, the new tank, connections and an expansion tank, itemized with crew hours.

Direct answer: Replacing a 50-gallon gas water heater like for like costs about $3,128 to $4,812, from a direct job cost of $2,406 for this swap. Direct job cost is labor and materials only, with no contractor overhead or profit, and is not a price: no contractor performs work at job cost. Permit and inspection fees are not included.

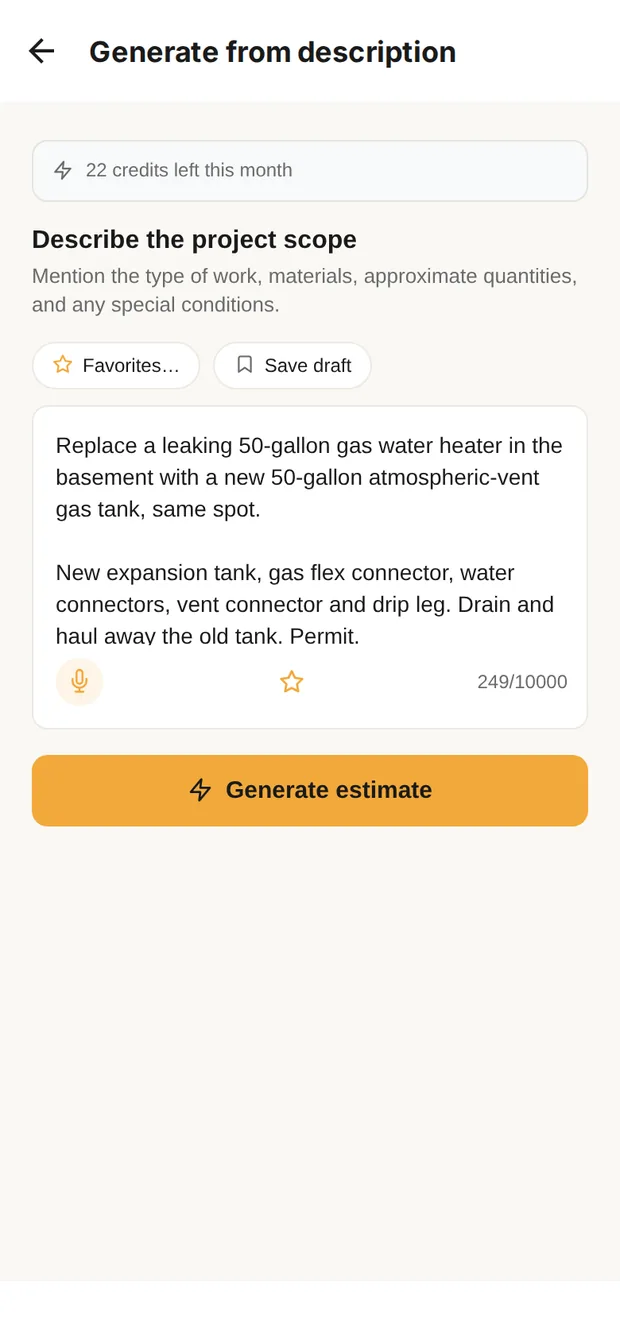

Clamp's Generate from description screen with the gas water heater swap described in plain words

Describe it

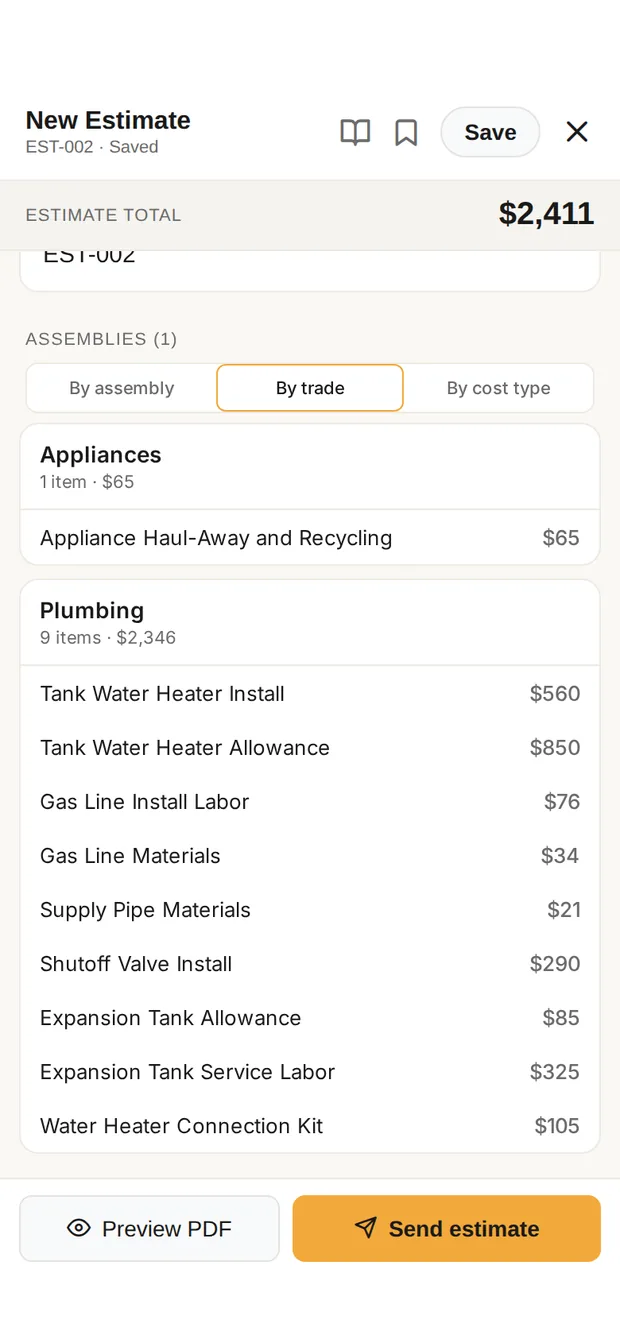

The estimate for the gas water heater swap in Clamp's builder: total $2,406.00, grouped by trade

Every line, by trade

The water heater swap in the Clamp app: described in plain words, then the estimate at $2,406 job cost, every line grouped by trade. Sample data. Illustration of the Clamp app.

The job at a glance

One build, fully itemized, with crew hours.

BuildJob costLaborCrew hoursMaterialsIllustrative selling price
A. 50-gallon gas tank, same spot$2,406$1,2516 to 11 h$1,095$3,128 to
$4,812

Dump fees and other costs ($60) are the same in every build and included in the job cost. Materials include allowances. Illustrative selling price is the job cost at a 30% to 100% markup; your price depends on your own overhead and profit. Labor hours are a planning range and include setup, daily cleanup and material runs; they are never a charge to the customer. Permit and inspection fees are not included; requirements vary by jurisdiction.

Which price is closer to yours?

  • Lean, +30%: A handyman or owner-operator who does the work with a small crew and no office. Usually the lowest quote. The owner handles scheduling, questions and callbacks around the work itself.
  • Standard, +50%: A remodeling company with a crew, an office, insurance and someone to answer the phone. Close to the average remodeler's overhead in the National Association of Home Builders cost-of-doing-business survey.
  • Full-Service, +100%: A design-build firm with designers, a salesperson and a project manager who runs the job. The extra pays for planning, coordination and one point of contact from design to final inspection.

Higher markup means more business behind the job, not by itself better work, and a lower markup is not by itself a better deal. For contractors: how each markup splits into overhead and profit is in the overhead categories guide.

The build in detail

A. 50-gallon gas tank, same spot: $2,406

The leaking tank is drained, disconnected and hauled away; a new 50-gallon atmospheric-vent gas tank is set in the same spot with a new gas flex and drip leg, vent connector, water connectors, shutoff valves and an expansion tank. Labor is $1,251 of the $2,406 job cost, or 52.0%. It is about 6 to 11 hours of work, including setup, daily cleanup and material runs.

Labor cost by trade

Labor only. Materials, allowances and dump fees are in the line items below. Hours are person-hours at typical production from Clamp’s labor hours catalog, as a range: a planning figure, not a schedule and not a charge to the customer.

TradeHoursLabor costLean×1.30Standard×1.50Full-Service×2.00
Plumbing5 to 10 h$1,251$1,626$1,877$2,502
Setup, cleanup and material runs1 to 2 hin the prices
All labor6 to 11 h$1,251$1,626$1,877$2,502

Every line item

Labor $1,251 + materials and allowances $1,095 + dump fees and other $60 = $2,406 direct job cost. Hours are person-hours at typical production, on labor rows only, and the direct-cost row adds about 15% for setup, daily cleanup and material runs; an allowance or material row names the labor line that installs it, and a subcontract row has none, because the sub’s price includes their own time. Some labor quantities include a difficulty factor, so they can exceed the measured area; each row’s derivation is in the downloadable data.

ItemQtyUnitHoursLaborMaterialLine cost
Plumbing
Expansion TankLabor on: Expansion Tank Install Labor1ea$0$85$85
Expansion Tank Install Labor1ea1 to 2 h$325$0$325
Gas Line Install Labor4lfunder 1 h$76$0$76
Gas Line MaterialsLabor on: Gas Line Install Labor4lf$0$34$34
Supply Pipe Materials6lf$0$21$21
Shutoff Valve Install2ea1 to 3 h$290$0$290
Tank Water HeaterLabor on: Tank Water Heater Install1ea$0$850$850
Water Heater Connection KitLabor on: Tank Water Heater Install1ea$0$105$105
Tank Water Heater Install1ea2 to 6 h$560$0$560
Plumbing subtotal5 to 10 h$2,346
Plumbing subtotal5 to 10 h$2,346
Cleanup & Disposal
Appliance Haul-Away and Recycling1ea$0$0$60
Cleanup & Disposal subtotal$60
Cleanup & Disposal subtotal$60
DIRECT JOB COST6 to 11 h$2,406
DIRECT JOB COST6 to 11 h$2,406

Methodology & reproducibility

One reviewed snapshot for this build. The build is frozen from its own estimate run and priced by the published pricer.

Direct cost equals the sum of each row’s rounded quantity × (labor + material + other). Amounts are shown in whole dollars; every column adds to its total.

Scope selection, prose accuracy, arithmetic and provenance mapping reviewed; not independent market-rate verification.

Questions

Why is the tank only part of the cost?

The tank allowance is the single largest line, but the swap also carries a plumber's half day, new shutoff valves, an expansion tank and the connection parts. A like-for-like swap stays modest because the gas line, vent and location are reused.

What can push this job higher?

A vent that no longer meets code for the new tank, a chimney that needs a liner, an undersized gas line, a power-vent or high-efficiency unit, or moving the tank. Each is its own line when it is found.

Is the markup on top of this?

Yes. Direct job cost is what the swap costs a contractor to perform. The markup table shows what it sells for at illustrative markups of 30% to 100%.

Related

Sources & provenance

  1. 50-gallon gas tank, same spot reviewed snapshot Clamp Research
Changes: Oct 12, 2026: Initial publication: reviewed snapshot frozen from a fresh estimate run, priced on the current baseline.; Oct 12, 2026: Added the app screenshot pair: the job described, then the draft by trade.; Nov 10, 2026: Search Console pass: the title and the summary carry the price range the answer gives. No job cost changed.; Nov 10, 2026: Repriced at the November 2026 catalog from the same saved estimate run. Appliance haul-away is $60 (was $65). Direct job cost $2,406 (was $2,411).
